In May 2025 we took on a pink shop on Bramley high street. The plan was
straightforward. Clear it out, tidy it up, five reformers in, open by
the autumn.
Since then a ceiling has come down, a floor has come up, a scaffold
tower has fallen through that floor, five reformers have lived in a
storage unit for four months, and my father has been to hospital and
back.
In our defence, the air conditioning has worked flawlessly since June
2025.
May 2025
It was very pink
Number 11, Bramley high street. Victorian shopfront, handsome mouldings,
original tiled step, and a colour best described as committed. The
previous tenant's shipping-company nameplate was still in the window.
Inside was an office. Desks, filing cabinets, a world map, and a carpet
the colour of a wet Tuesday.
Still advertising a shipping company.The one thing we were never touching.Day one. Note the carpet.
Opening: Autumn 2025
June 2025
The entire studio, on one page

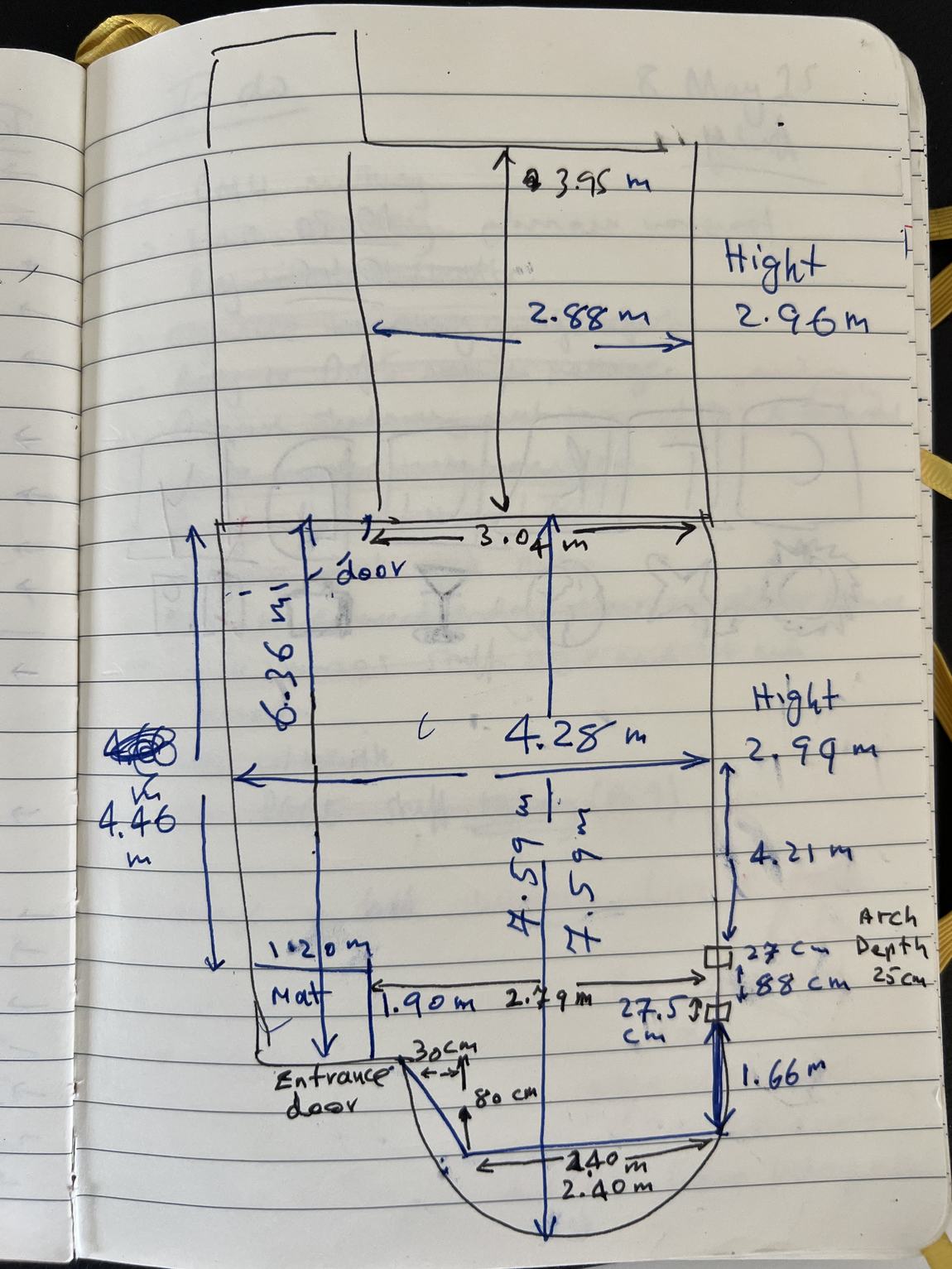

Every reformer, every walkway, every millimetre of clearance worked out
here first. 4.28 by 6.36, ceilings just under three metres, and an arch
we can tell you the depth of to the centimetre because we measured it
considerably more times than was necessary.
Opening: Autumn 2025
June 2025

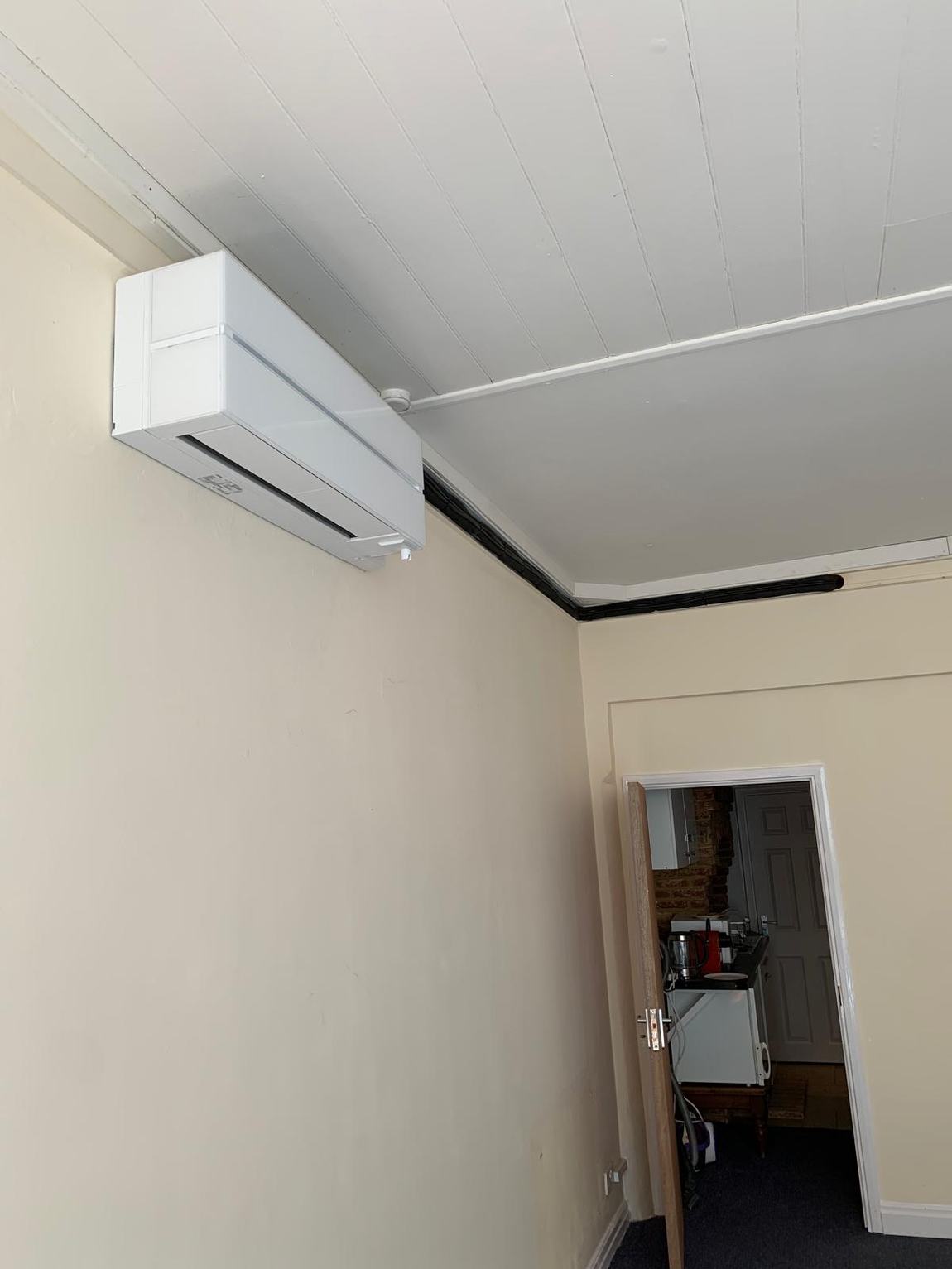

The first thing we installed
Not a floor. Not a ceiling. Not so much as a finished wall. The air
conditioning.
There was reasoning behind it. The coffers, the ventilation runs and a
good deal of the wiring all had to be planned around where the unit sat,
so it went in first and everything afterwards was arranged in deference
to it.
Given the summers since, it has earned its keep. But fitting air
conditioning before you own a floor is not a plan. It is optimism,
wall-mounted. We were building this studio from the ceiling down and I
did not notice for about a year.
Everything else in this photo is still original.
Opening: Autumn 2025
June — July 2025
Two months looking at paper
Colour swatches. Then more colour swatches. Then the same swatches taped
to the wall, so they could be looked at in a different light and
disagreed about again.
This is the process by which several dozen near-identical off-whites
became four: Rock salt, Just walnut, Caramel latte, Perfectly taupe. We
stand behind every one and would not survive doing it a second time.
A reasonable and proportionate number of options.Same colours, different wall, fresh argument.Herringbone or plank. This took a while.The survivors.
Opening: Christmas 2025
August 2025
A ceiling, drawn on an envelope

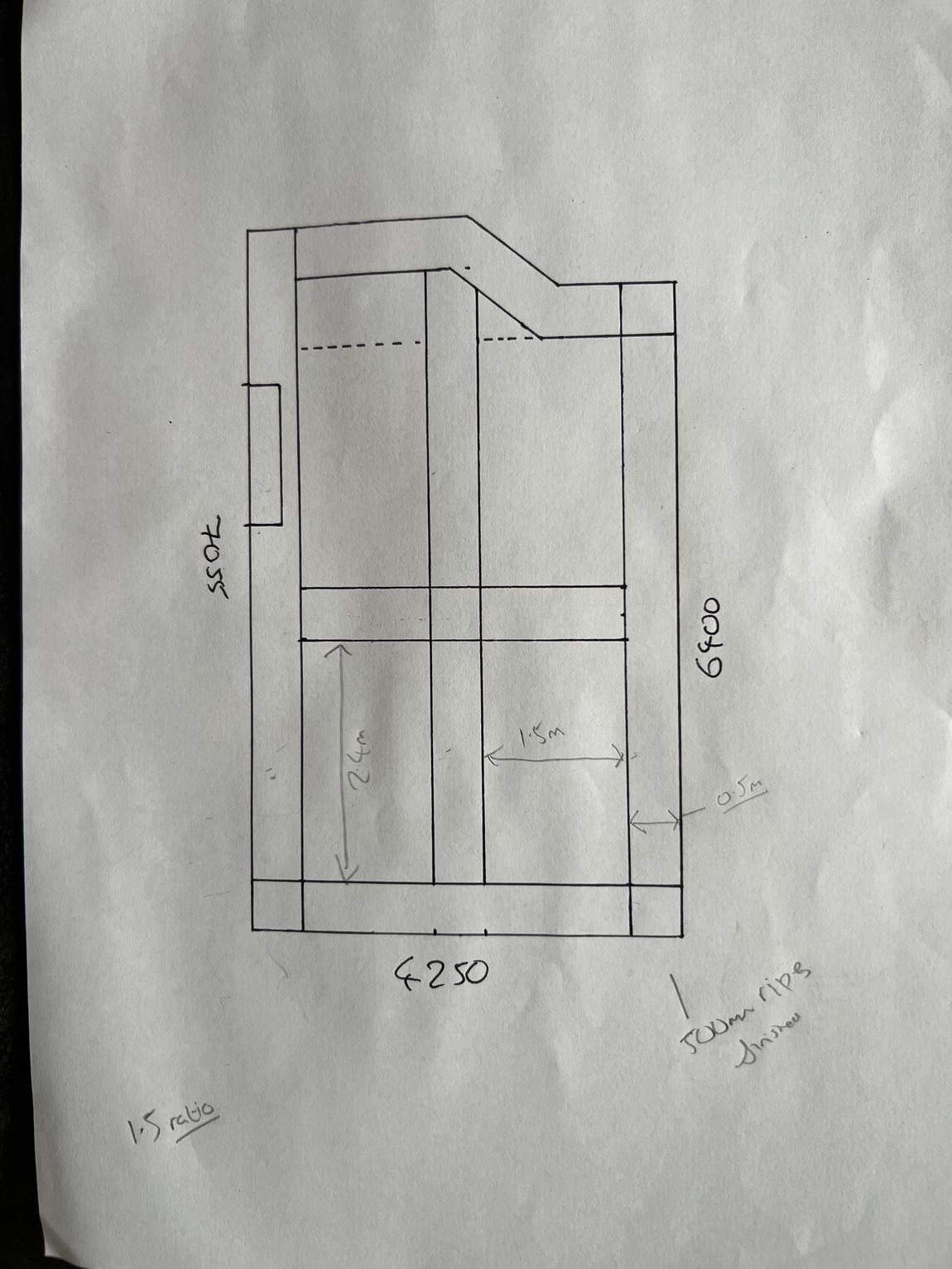

The coffered ceiling began as biro on a sheet of A4. A 1.5 ratio, 500mm
rips, and a handful of numbers that turned out — remarkably — to be
correct.
Meanwhile the office contents had to go somewhere, so the garage was
emptied by a man in a dust mask and his mother, who gave a thumbs up
about it.
The entire ceiling design, at this stage.Family business.
Opening: Christmas 2025
September — December 2025
Nothing whatsoever
There are no photographs of autumn 2025 because there was nothing to
photograph. Quotes were sought. Trades were booked elsewhere. Christmas
arrived on schedule, unlike everything else.
Four months, no pictures, no progress. Every build has this chapter and
nobody ever puts it in the montage.
No photographic evidence
Opening: Spring 2026
January 2026
Down comes the ceiling
The dust was, and this is the technical term, insane.
Underneath: century-old joists and insulation that was, to everyone's
surprise, absolutely fine. Also a ceiling that turned out to be level
nowhere at all — established with a laser, then corrected batten by
batten across the entire room.

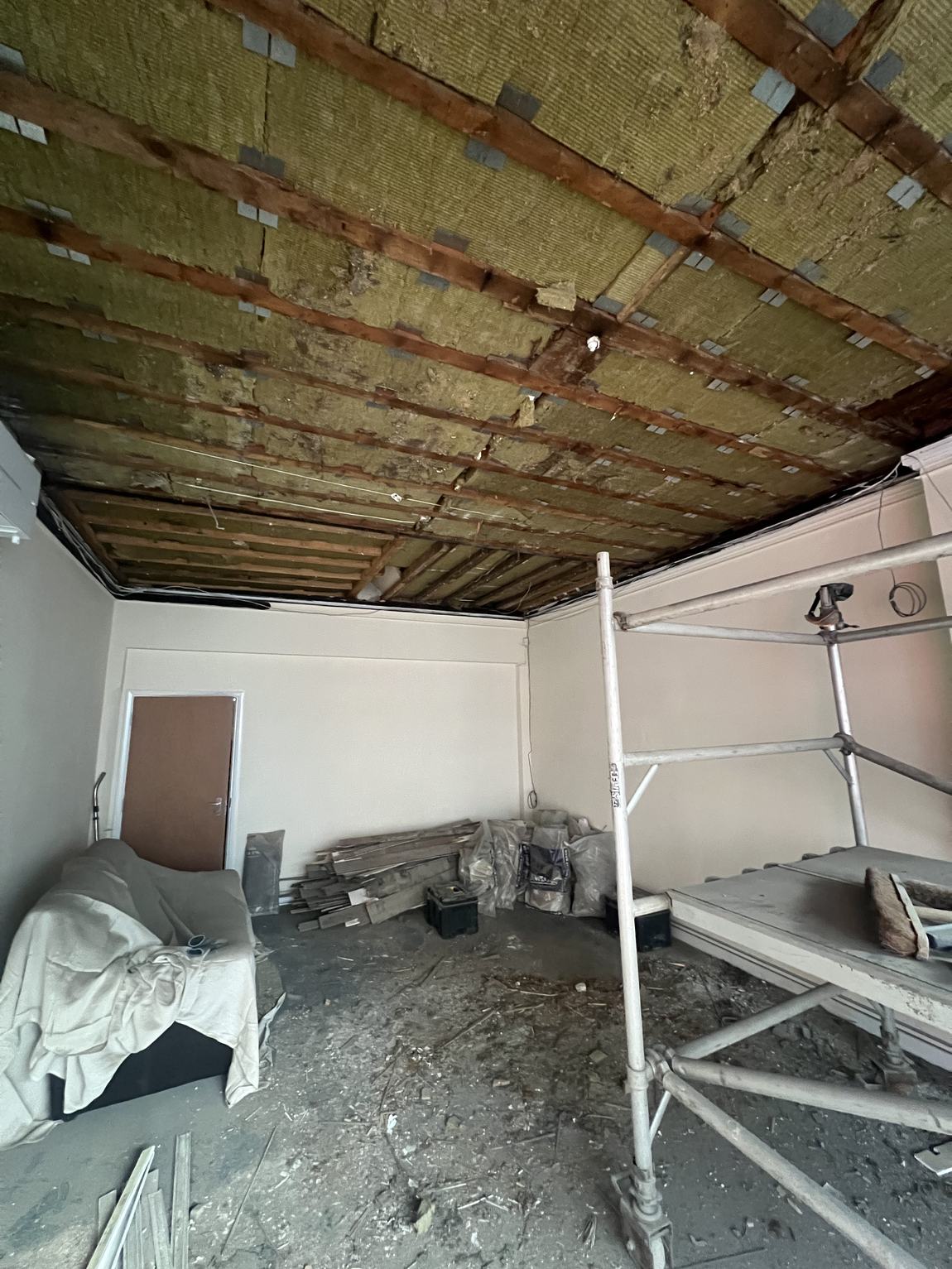

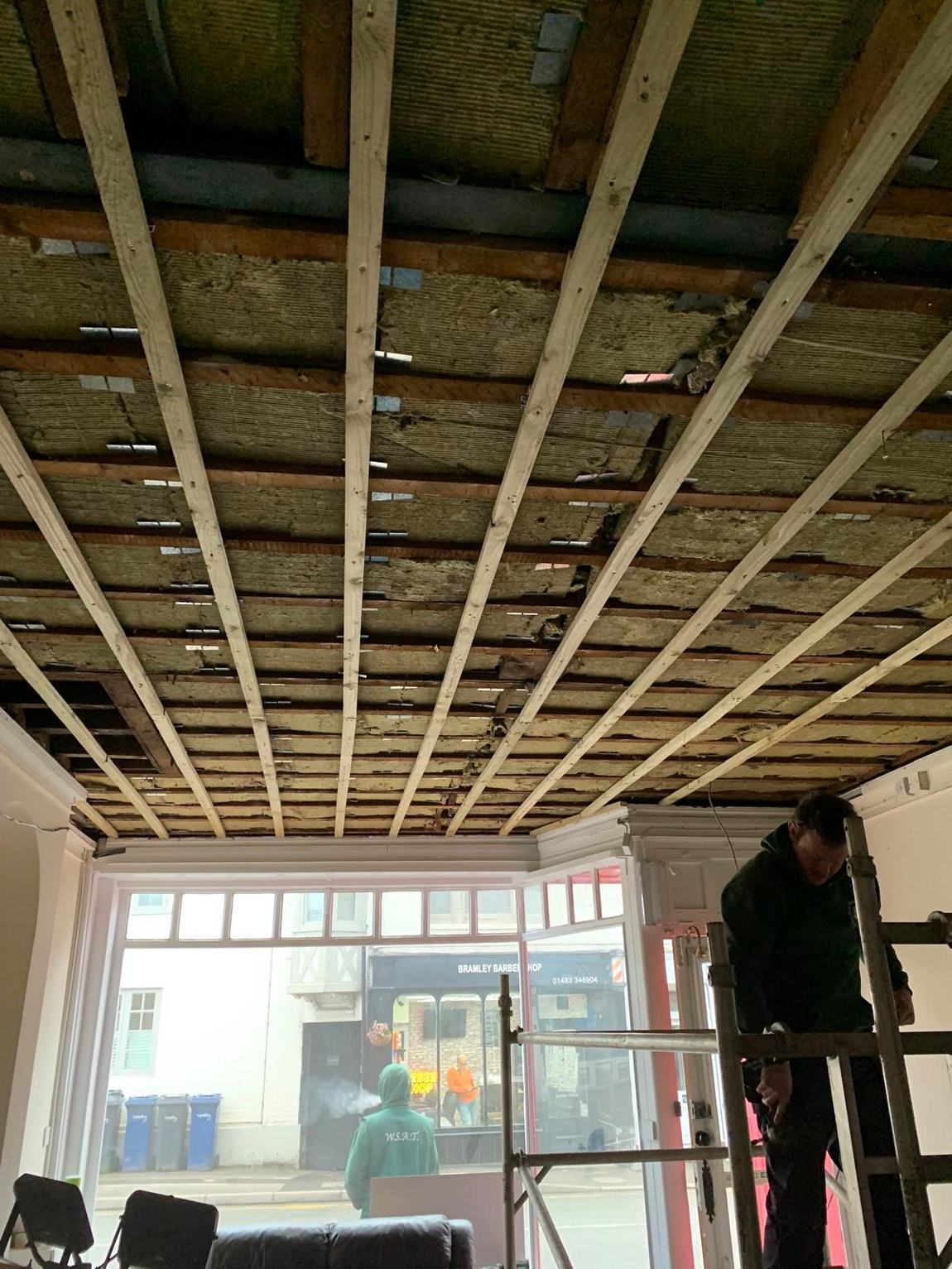

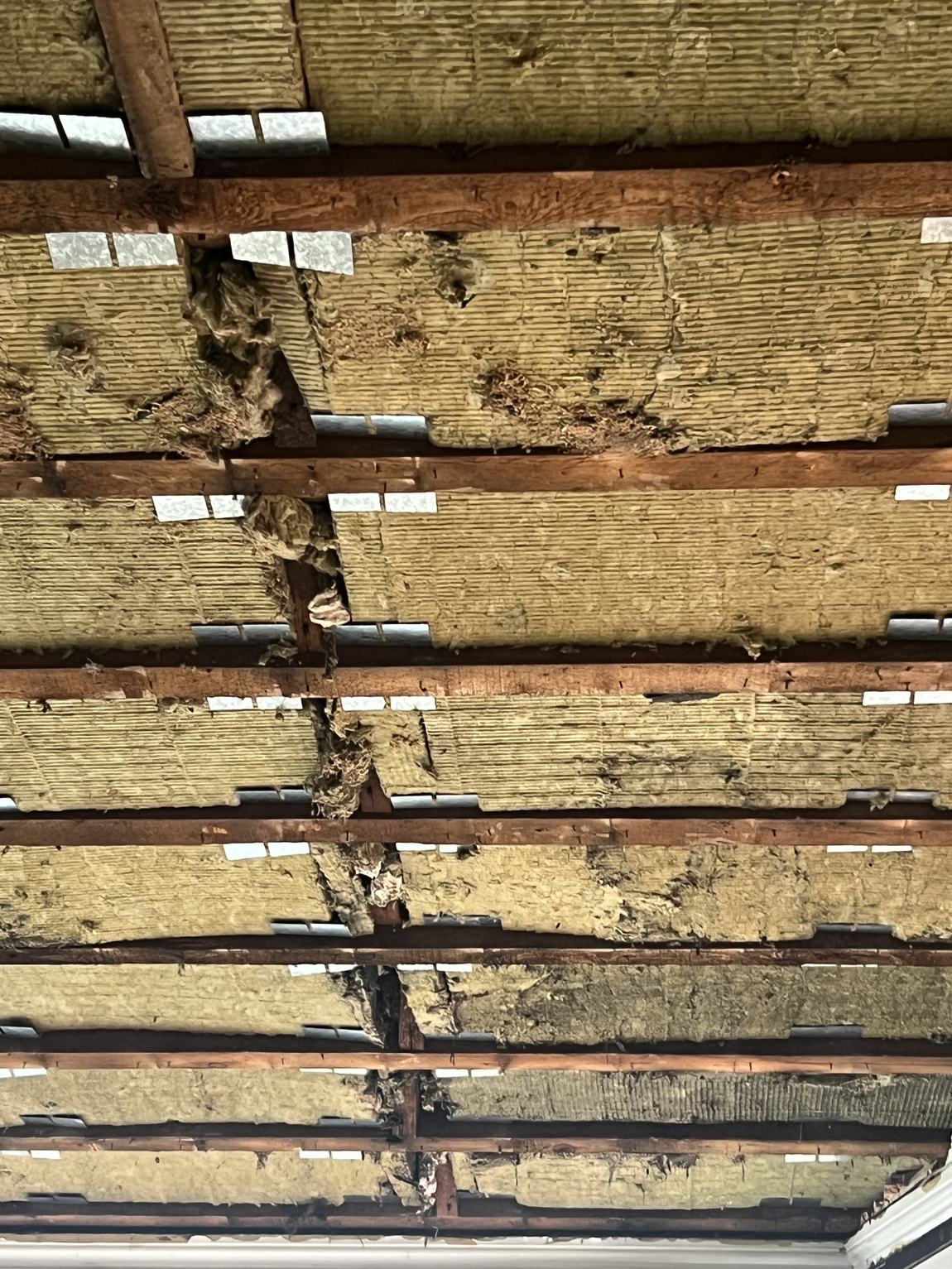

Every surface in Bramley had a light coating.A hundred years old and mostly still working.Level nowhere. Fixed everywhere.
Opening: Spring 2026
January 2026
Pink boards and an absurd quantity of wire

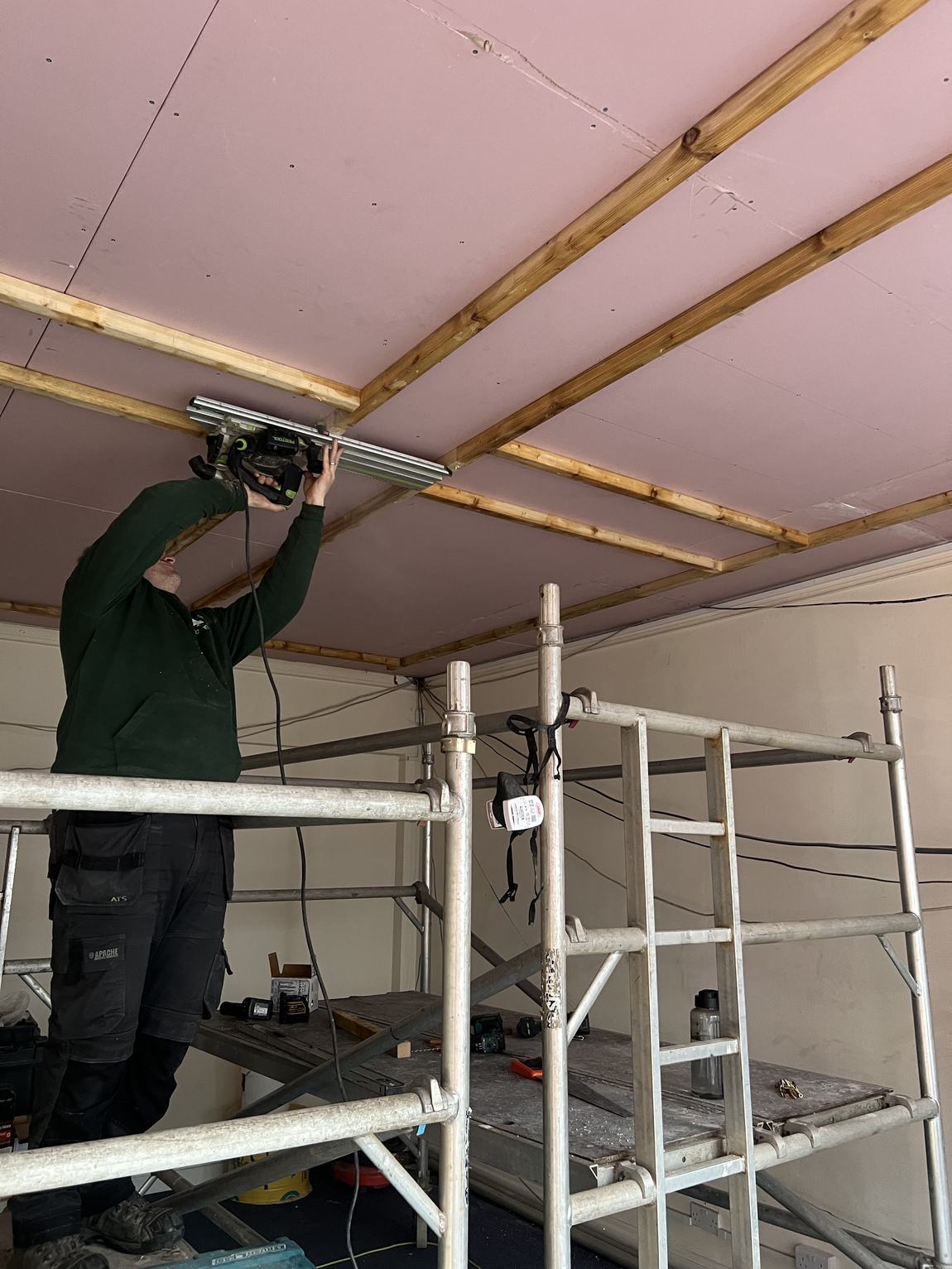

Fireproof board up, battens on to form the coffers.

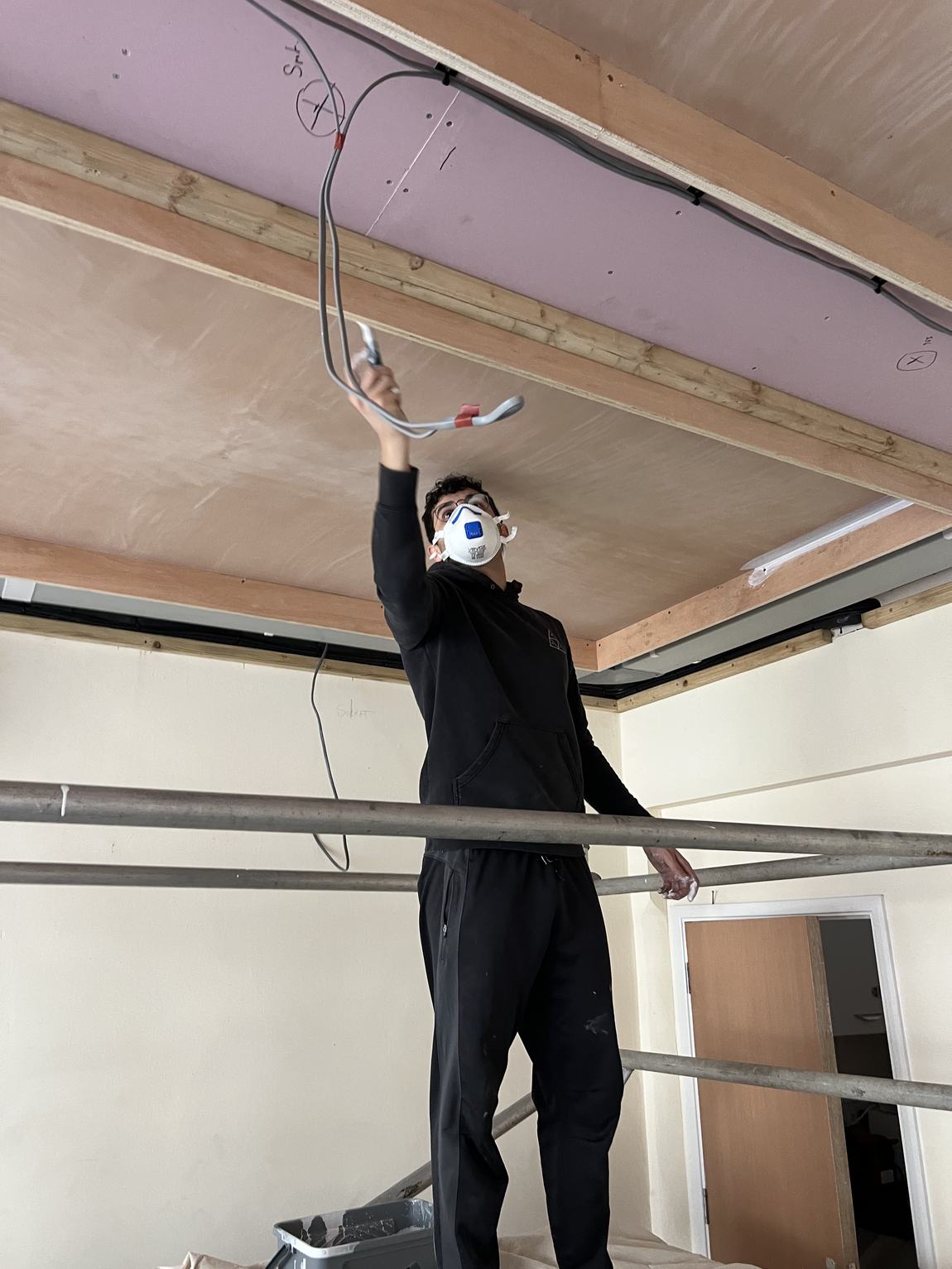

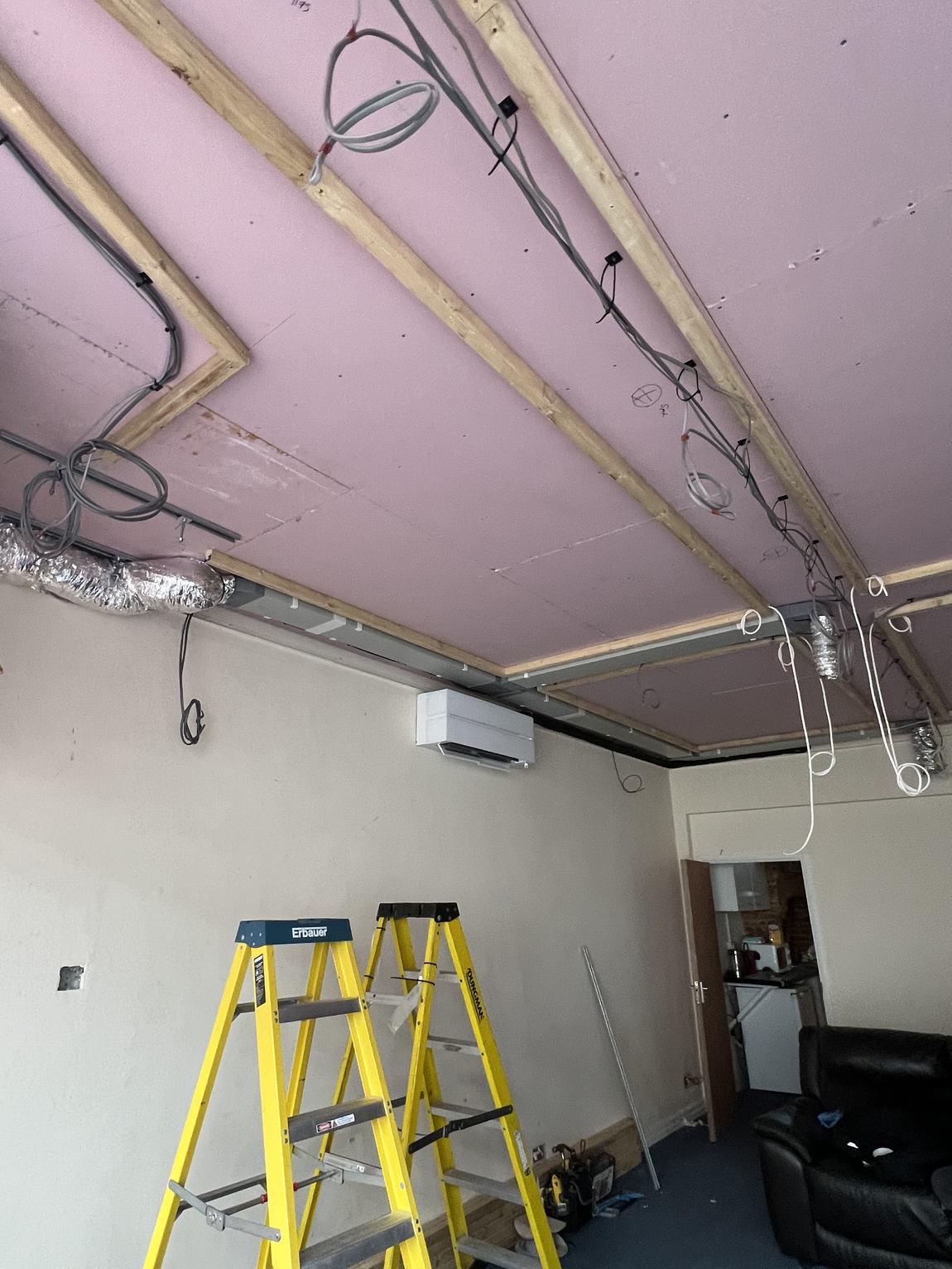

Normally the wiring runs above the boards. We ran ours inside the coffer
voids instead — it sits cleaner and nothing ends up buried where you
can't reach it. It also required roughly twice the cable anyone had
allowed for. Worth it. Still irritating.

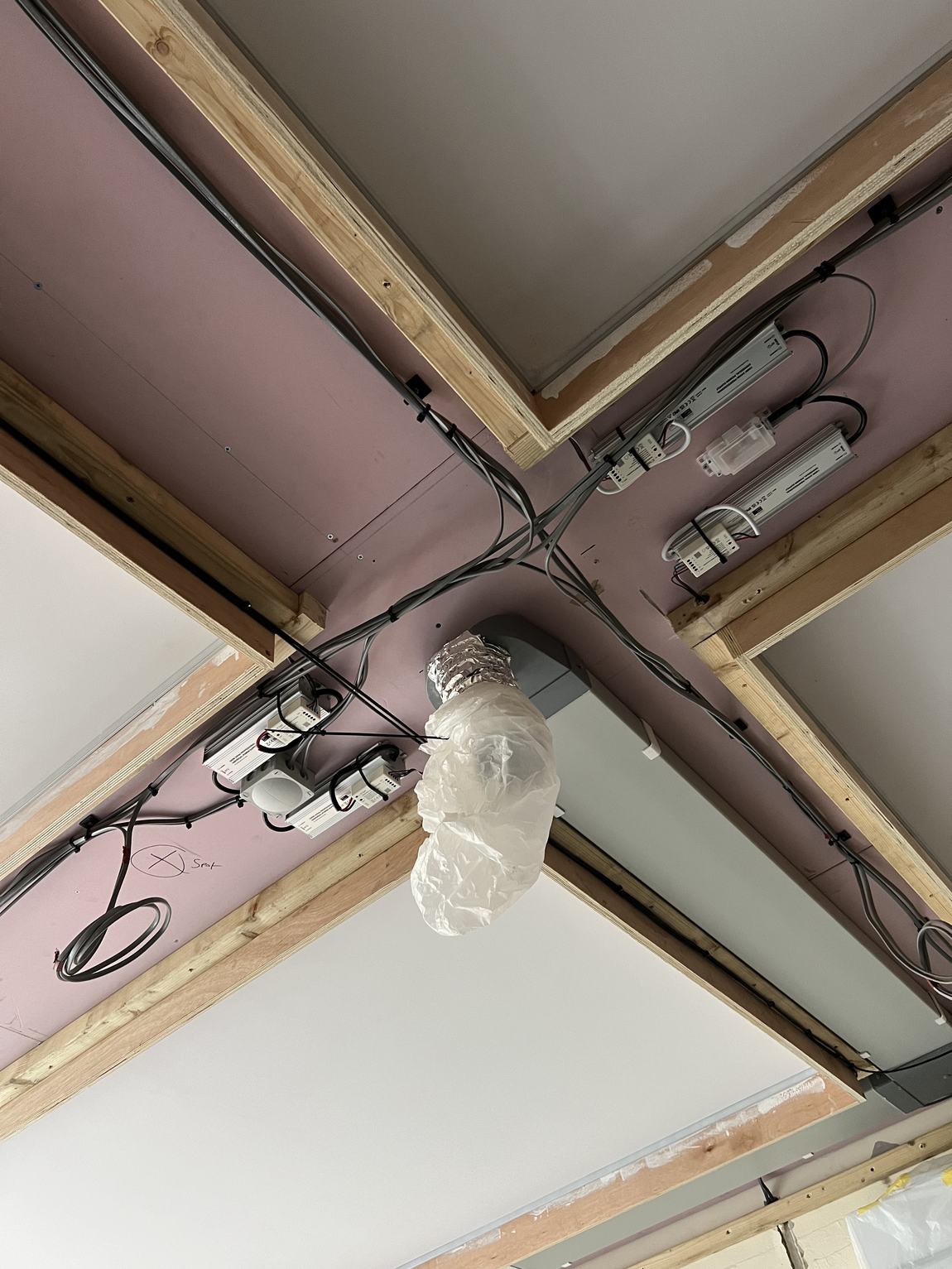

The shape arrives.All of this is now invisible.Ventilation, negotiating with the lighting.
Opening: Spring 2026
February 2026
The screens we very nearly forgot
Realised, late, that any screen in the studio needed its wiring in
before the ceiling closed for good. Marked up on the wall in pencil at
speed: 972 by 562, power here, 20cm across.
Another ten minutes and it would have been a genuinely expensive
oversight.

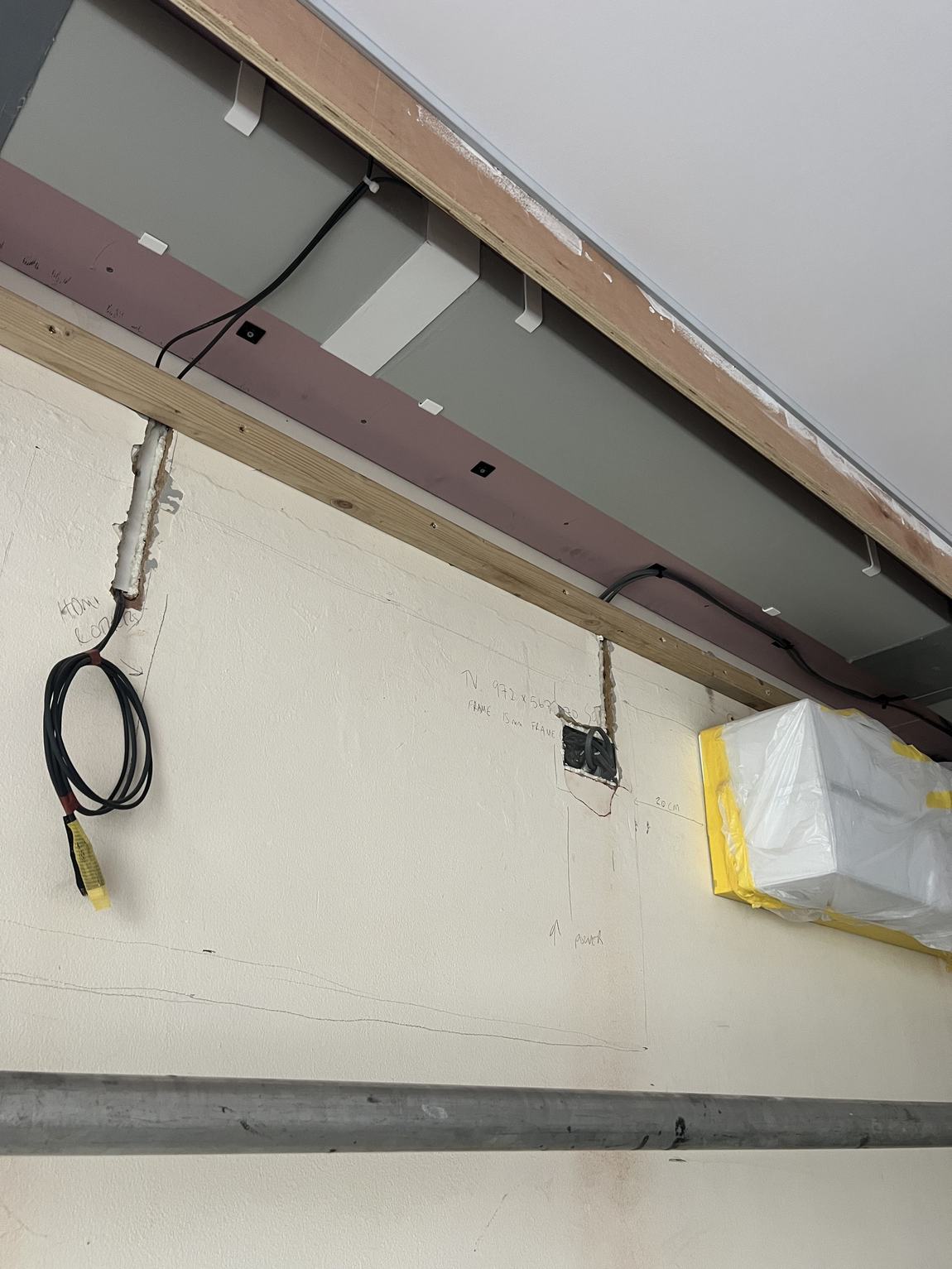

Written on a wall, in pencil, in a hurry.
Opening: Spring 2026
February 2026
Five reformers arrive from America

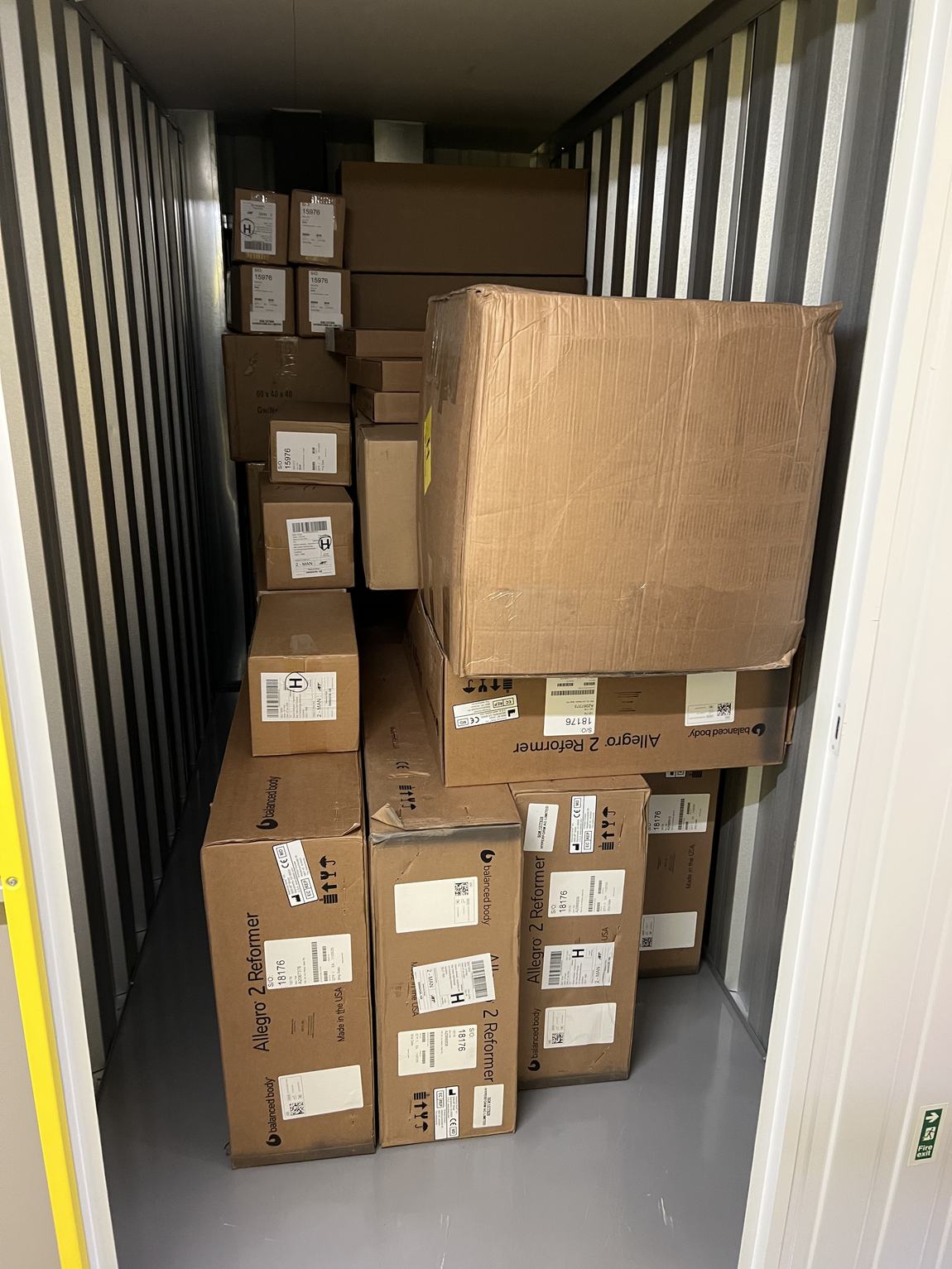

Balanced Body Allegro 2s, shipped from California, arriving at a studio
with no floor and half a ceiling. Into storage they went. Just for a
month or two.

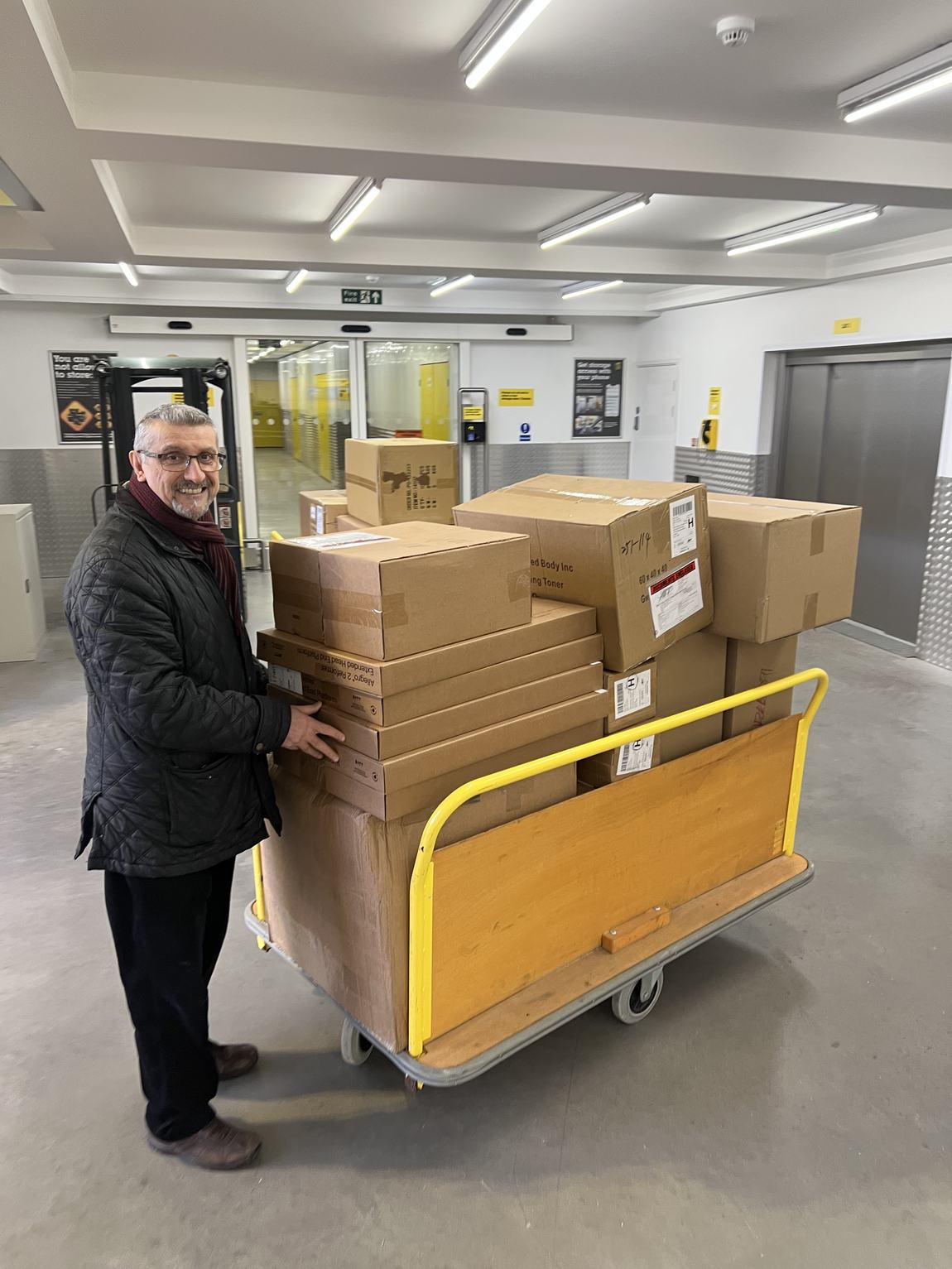

My seventy-year-old father and I moved every box by hand. Somewhere
around the third trolley run I remember thinking, with total sincerity,
that Big Yellow is an outstanding business.

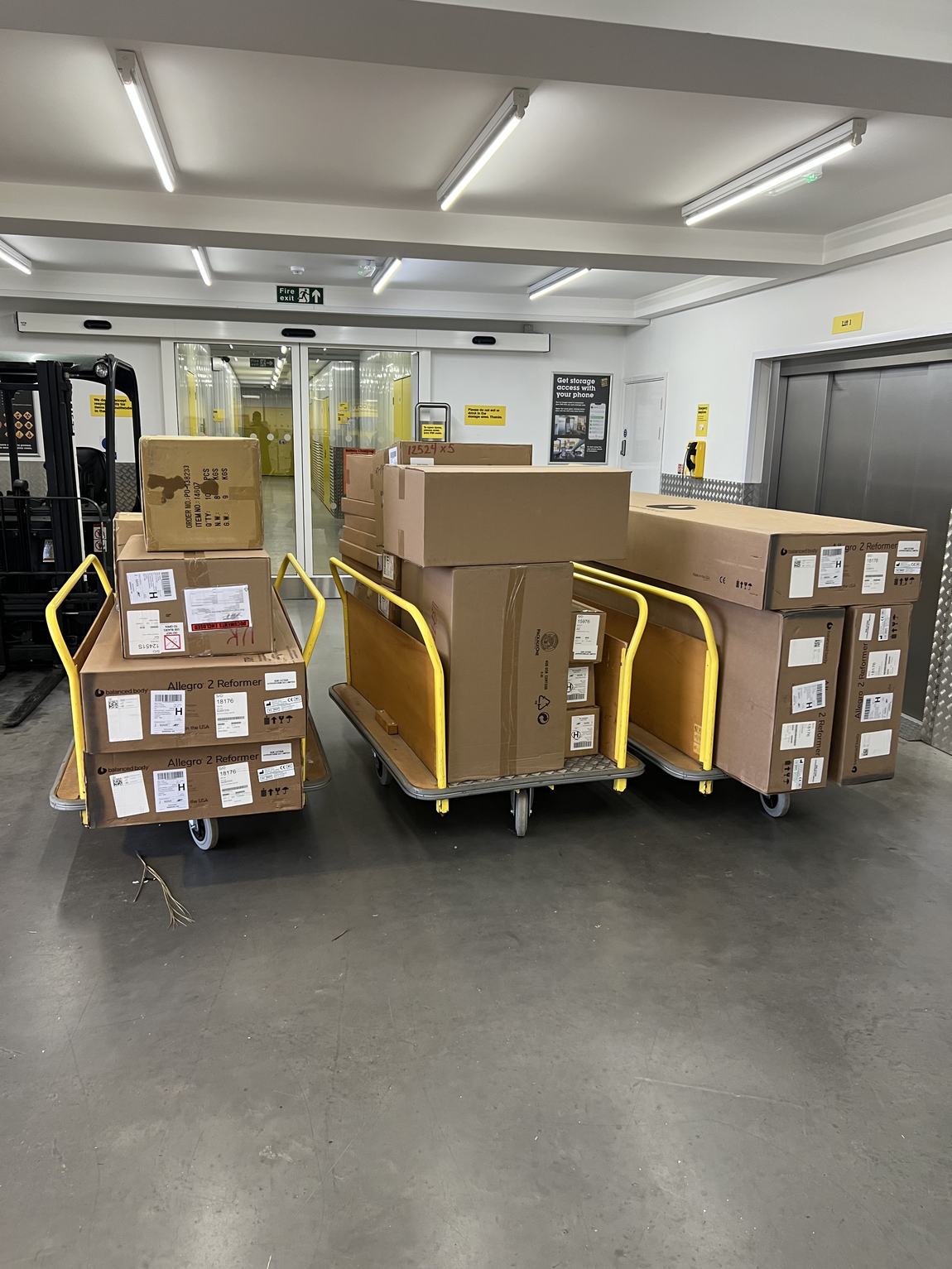

Seventy years old. Did not complain once.Considerably more boxes than anticipated."A month or two."
Opening: a month or two
February 2026
Paint
First coats on. This is the point where a building site starts behaving
like a room, and the point where I started getting properly excited —
which, with hindsight, was premature.

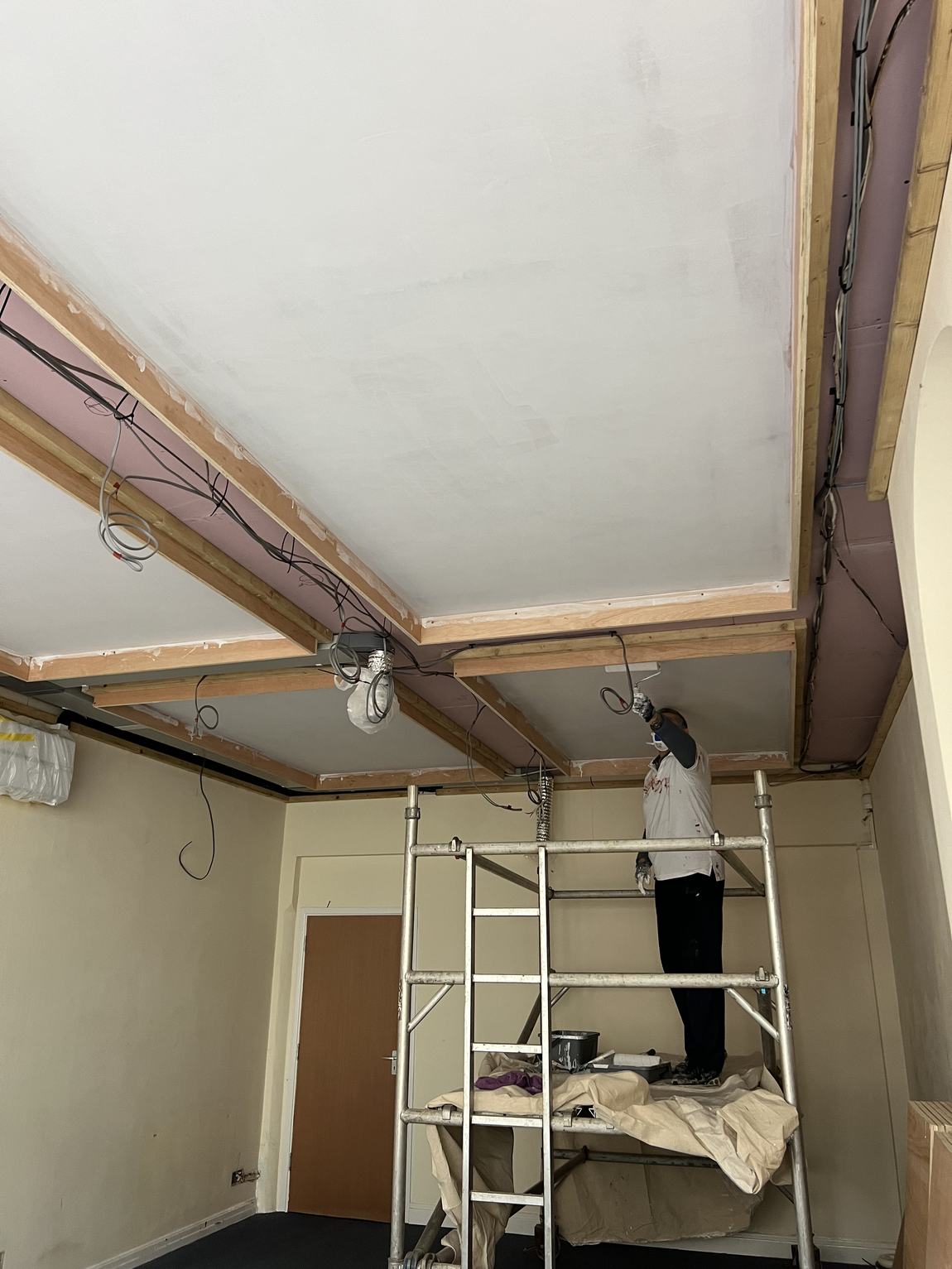

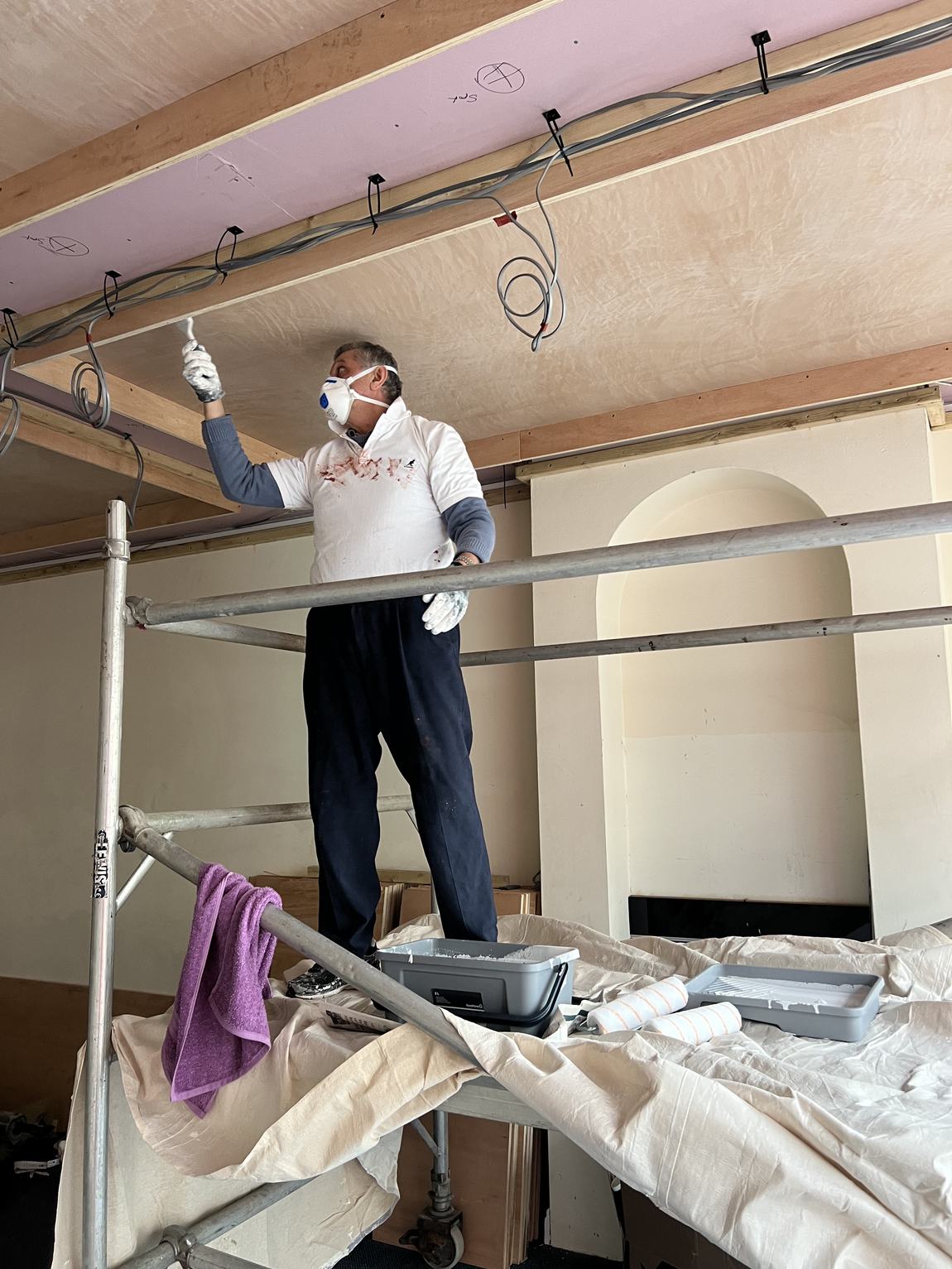

Back on the tower, roller in hand.White, at last.
Opening: Spring 2026
February 2026
The lights

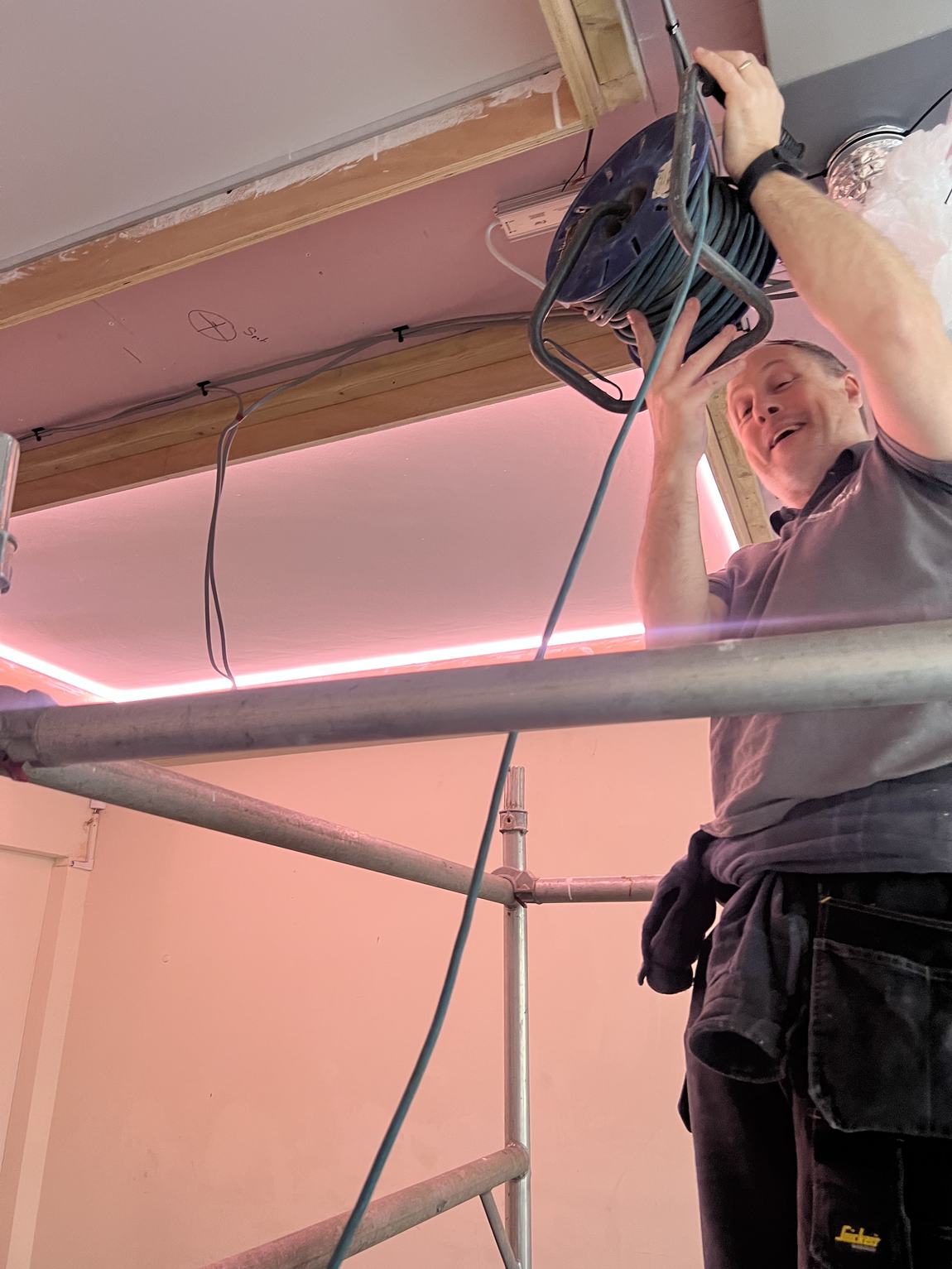

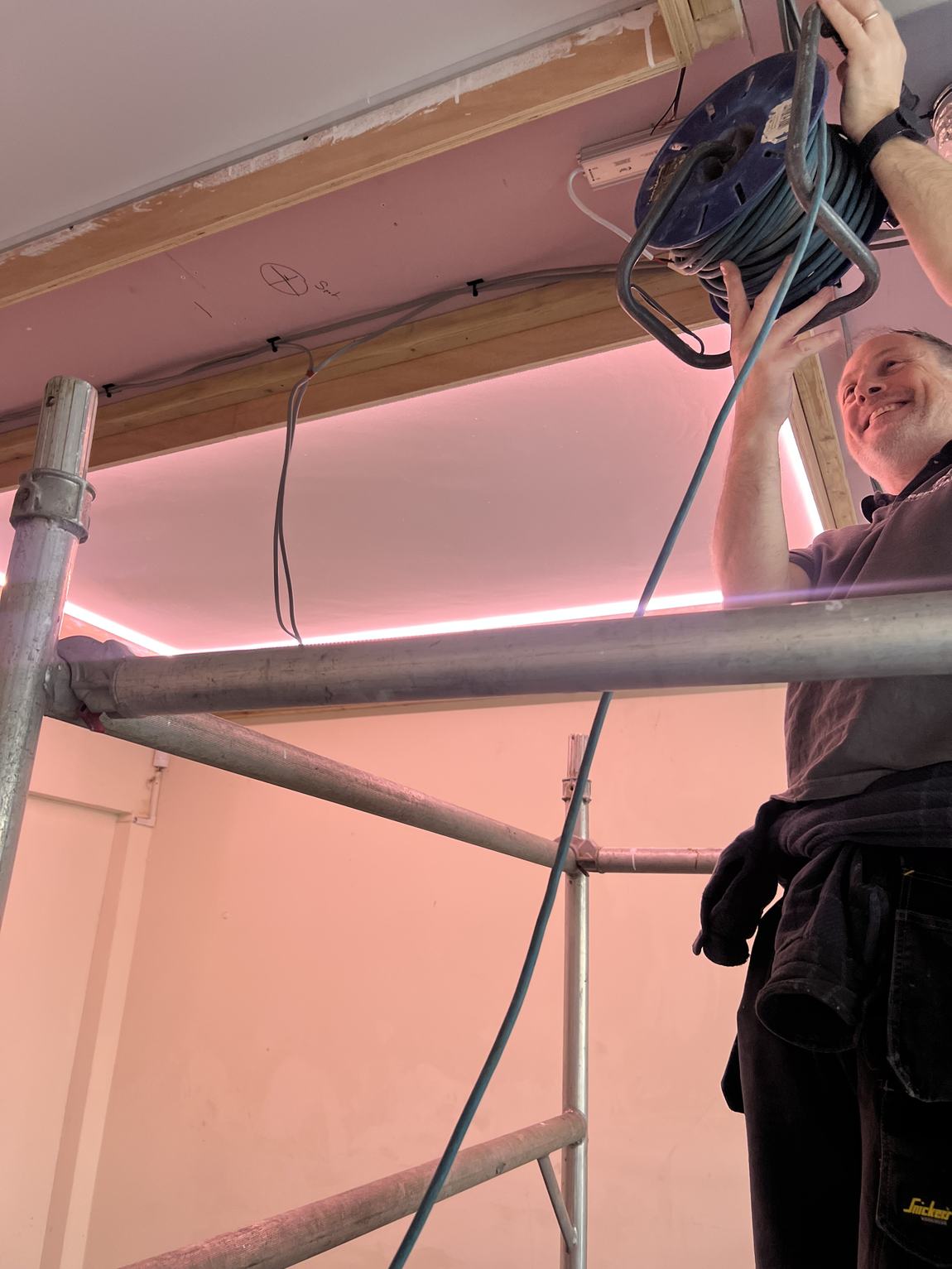

LED strip concealed in a shadow gap around every coffer. When Frazier
the electrician switched it on for the first time, neither of us said
anything for a bit.
Then we found the colour settings, and lost about forty minutes we will

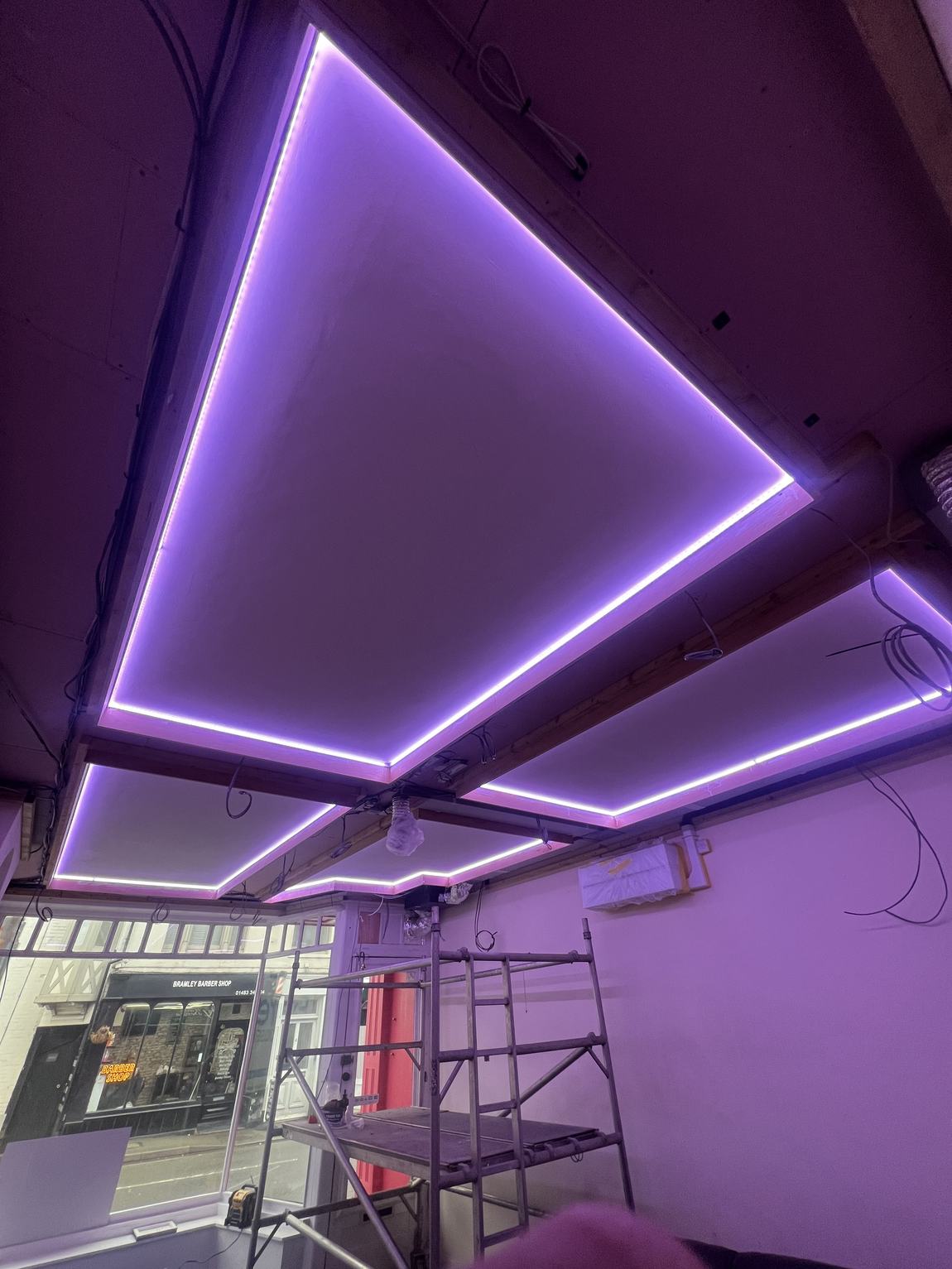

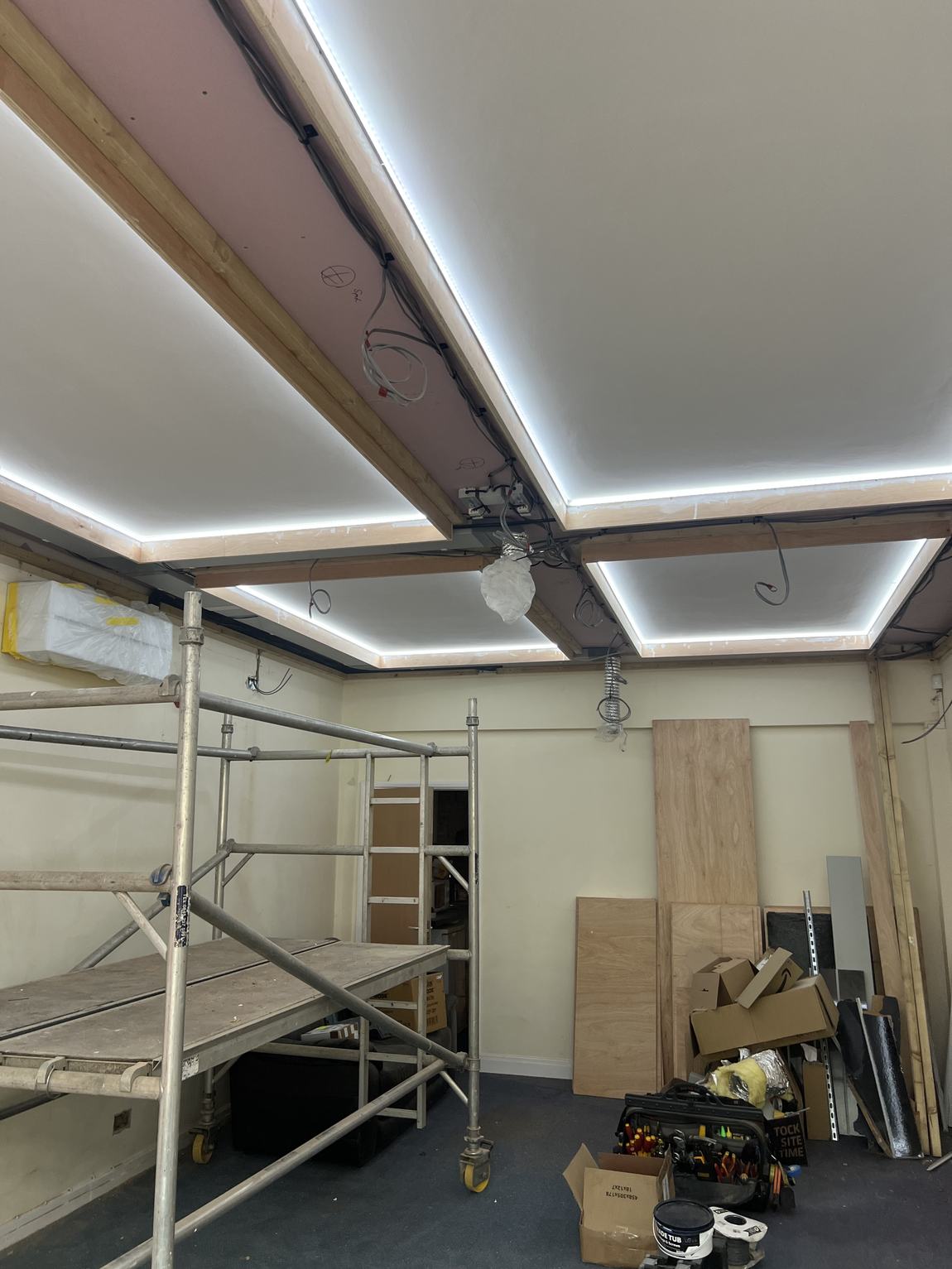

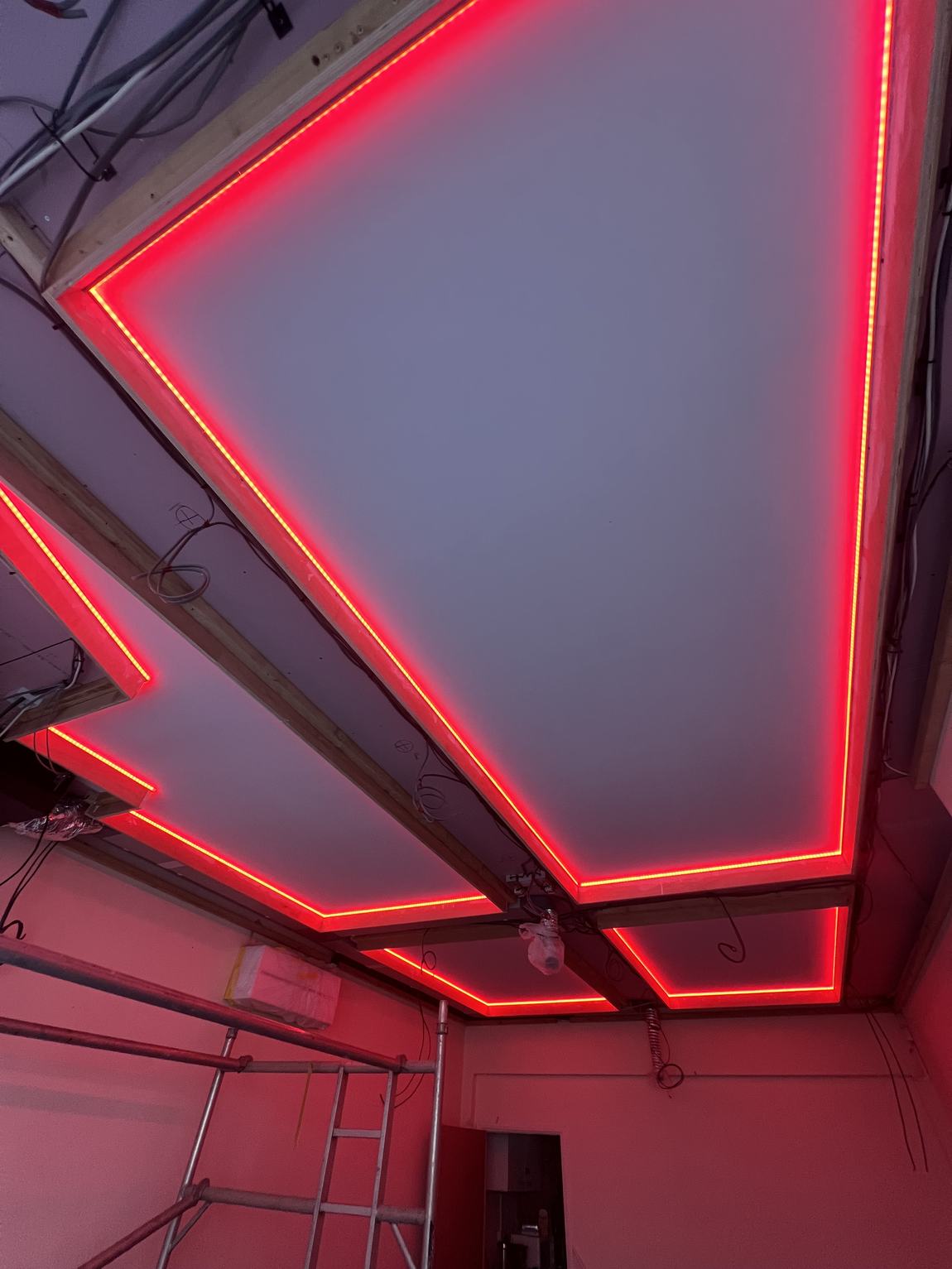

never recover. Red, purple, white. No regrets whatsoever.
The unglamorous half of a nice idea.Frazier, chuffed.Red.Purple.White. The sensible one. Eventually.
Opening: Spring 2026
March 2026
Then dad took a short break
Almost the same week the lights went on, my father Behrouz decided the
studio had had quite enough of his attention and checked himself into
hospital for a rest. He'd been on site more than anyone, so, fair enough.
He is completely fine, and was. This is him partway through beating the
entire ward at chess. Work restarted roughly the moment he was upright.
Taking the ward for everything it had.
Opening: we stopped guessing
March 2026
The ceiling, finished

Oak, spotlights on the beam centrelines, ventilation threaded invisibly

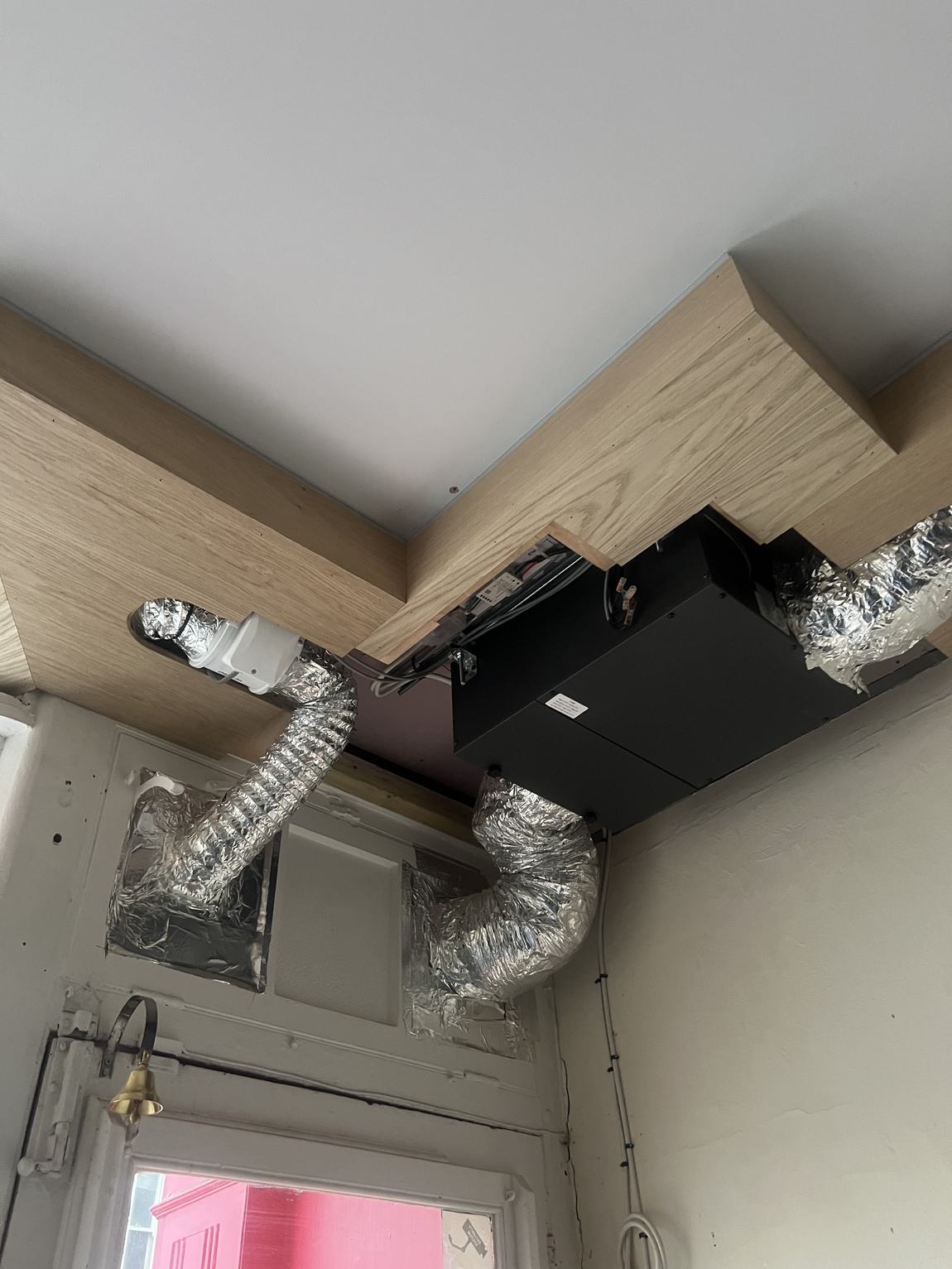

through the whole thing. Getting air both into and out of a room this
shape took more planning than the lighting did, and you will never
notice it, which is the entire point.

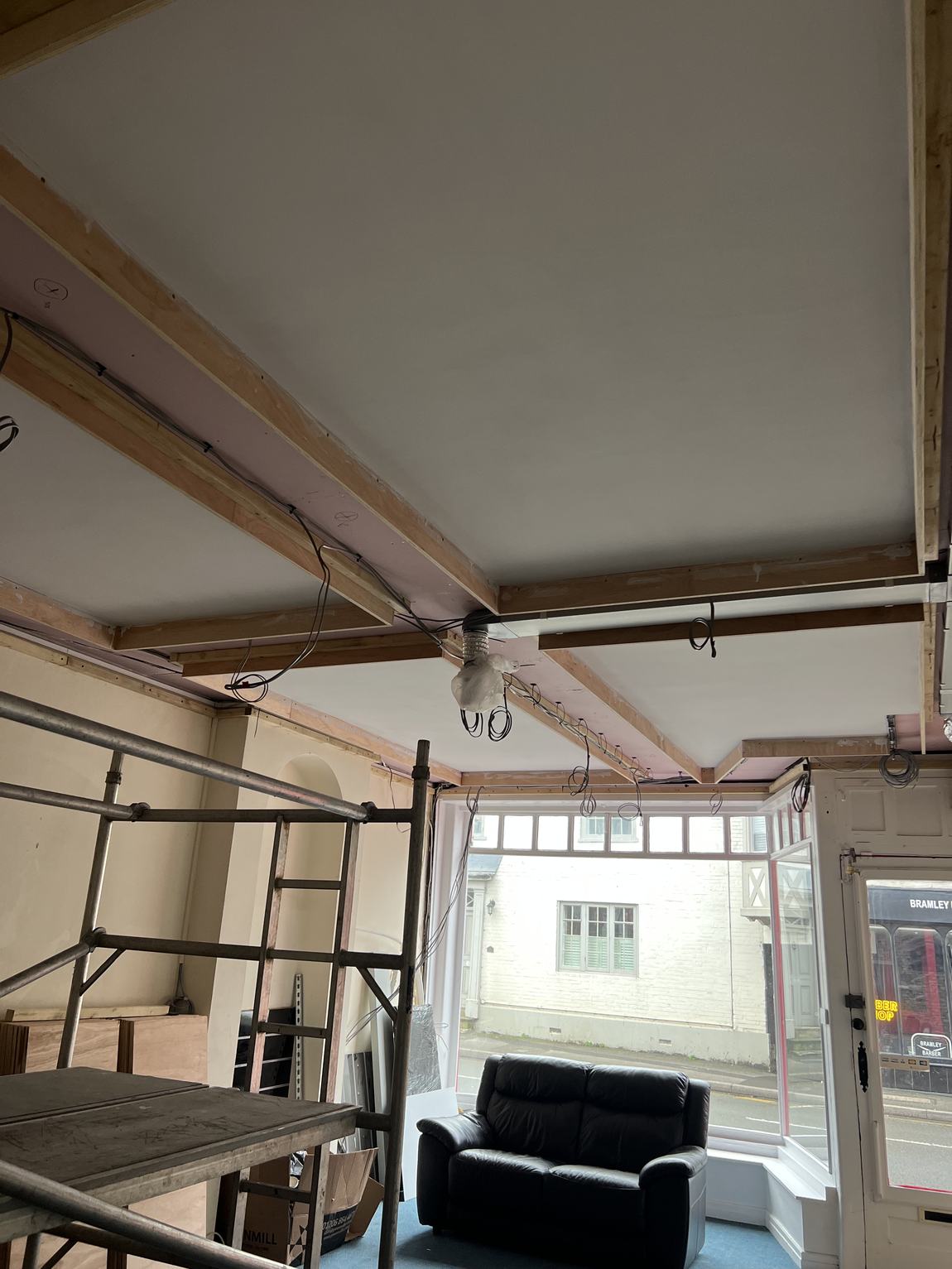

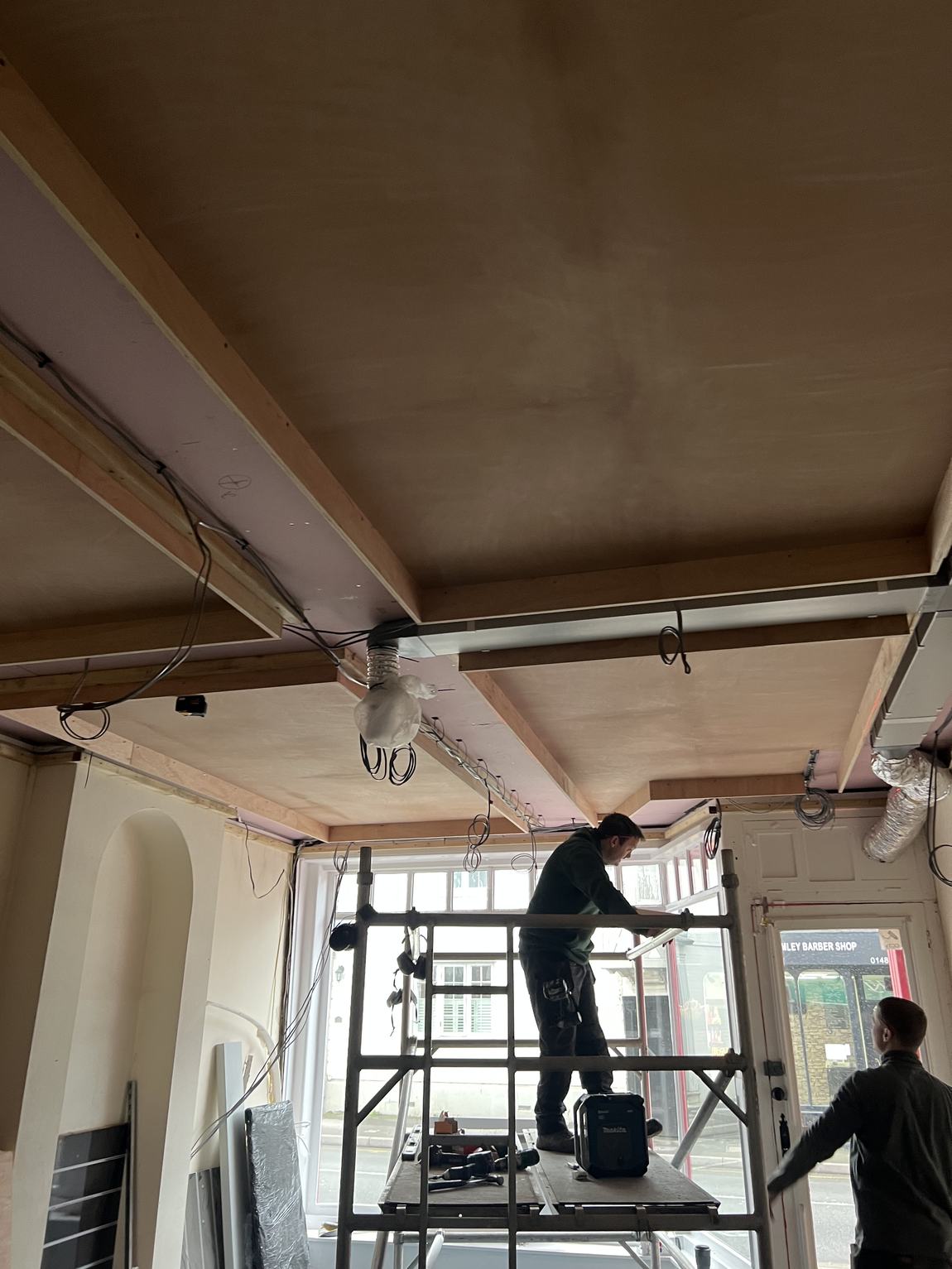

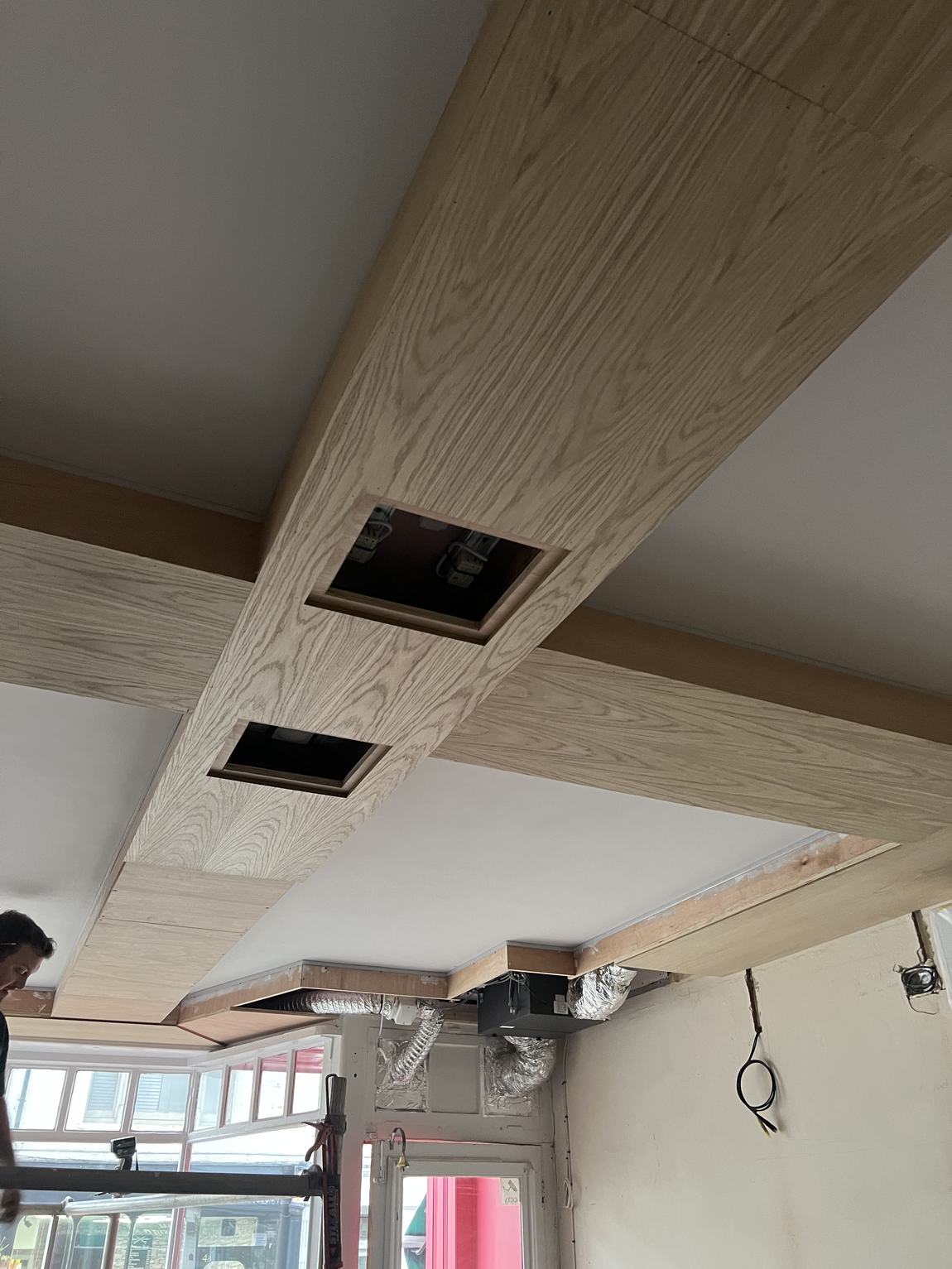

Nine months for this. Worth every one.Air in, air out, nothing on show.
Opening: Summer 2026
April 2026
The scaffold fell through the floor
That is not a metaphor. The internal scaffold tower put a leg straight
through the floorboards, and I did what anyone would do, which was
crouch down and have a look.
Damp. Rot through the subfloor. Not something you patch and forget with
twenty people a day on it.

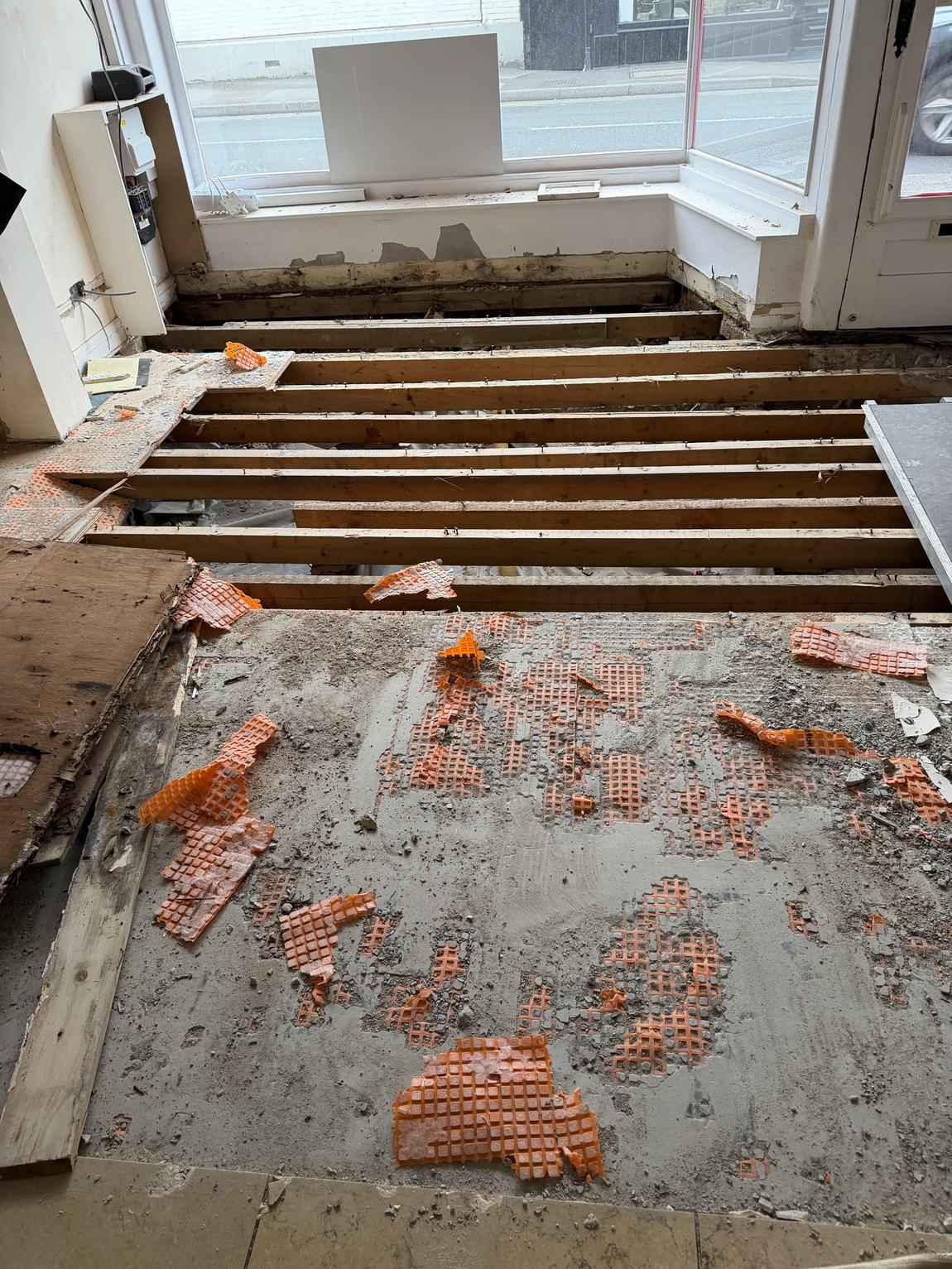

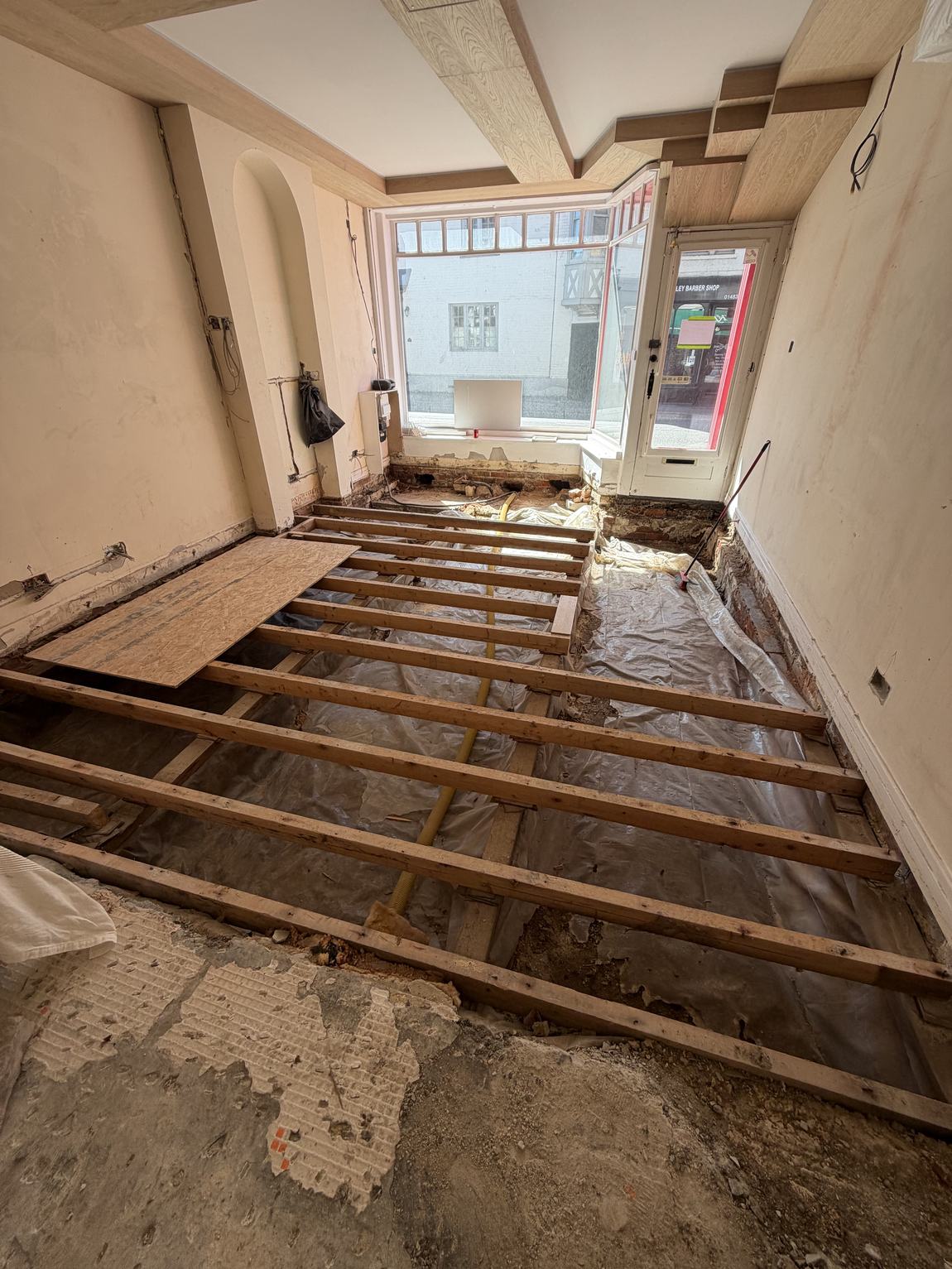

So the floor came up. All of it. Underneath a ceiling that was, by this
point, completely finished.
"I'll just take a quick look."The quick look.Damp, rot, and a void with nothing good in it.
Opening: Summer 2026
June 2026

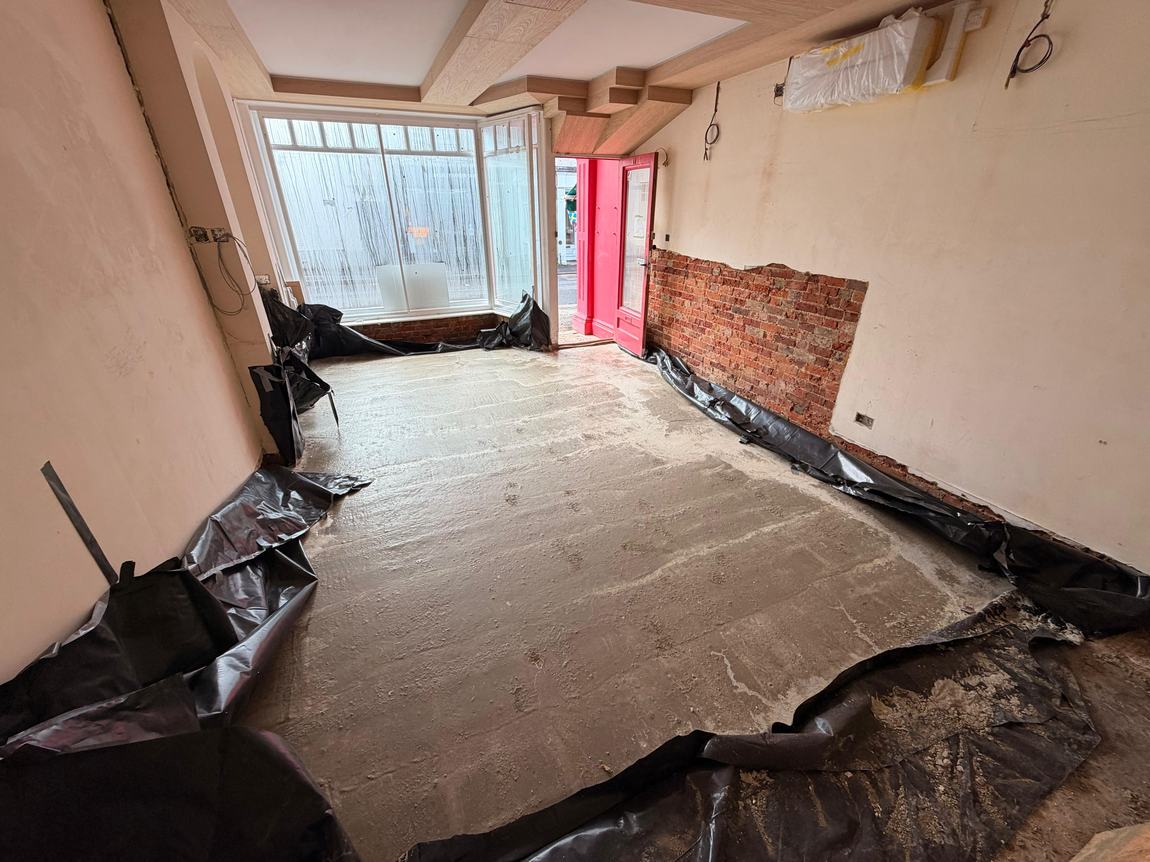

Concrete, and twelve weeks of waiting

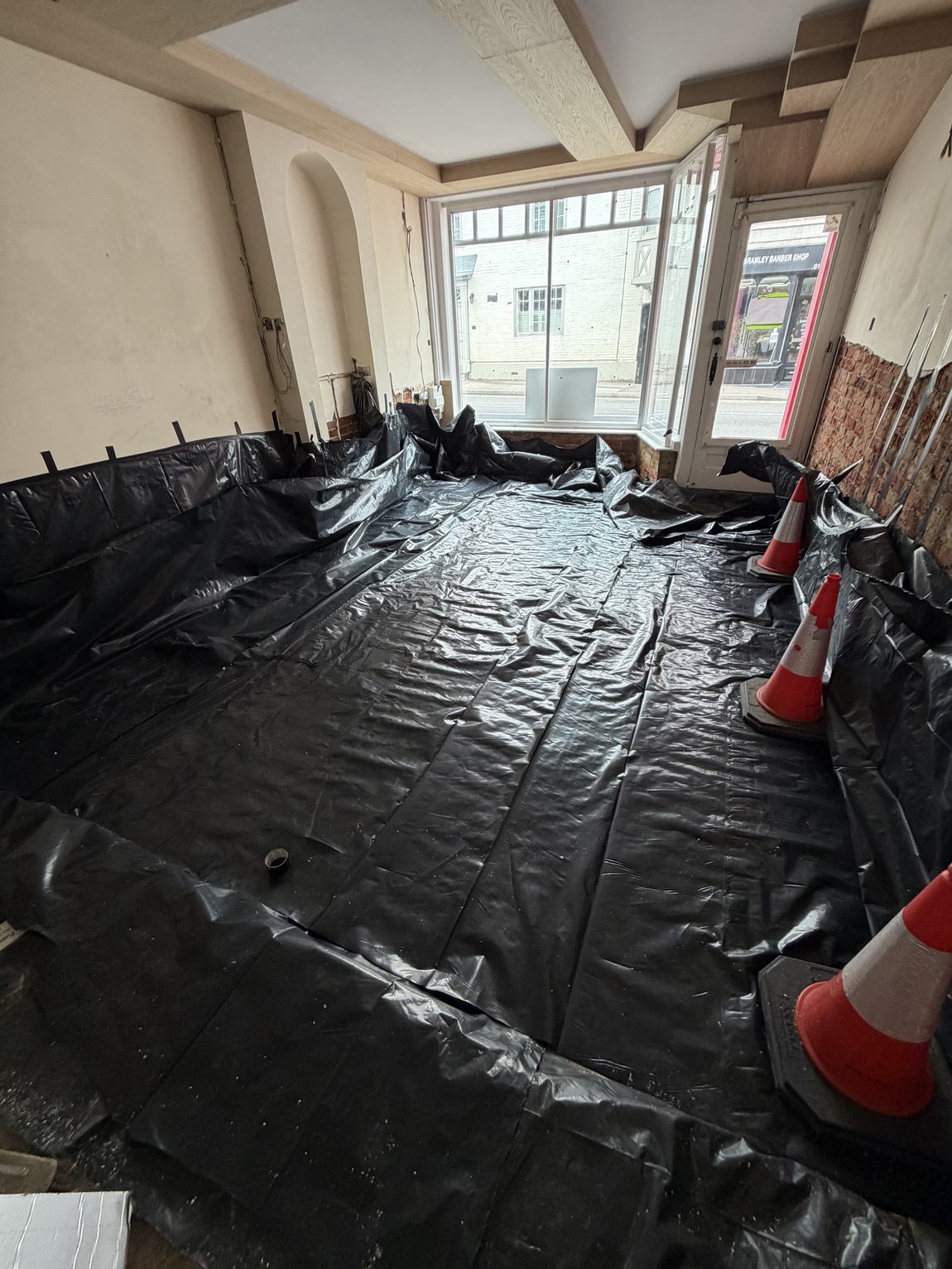

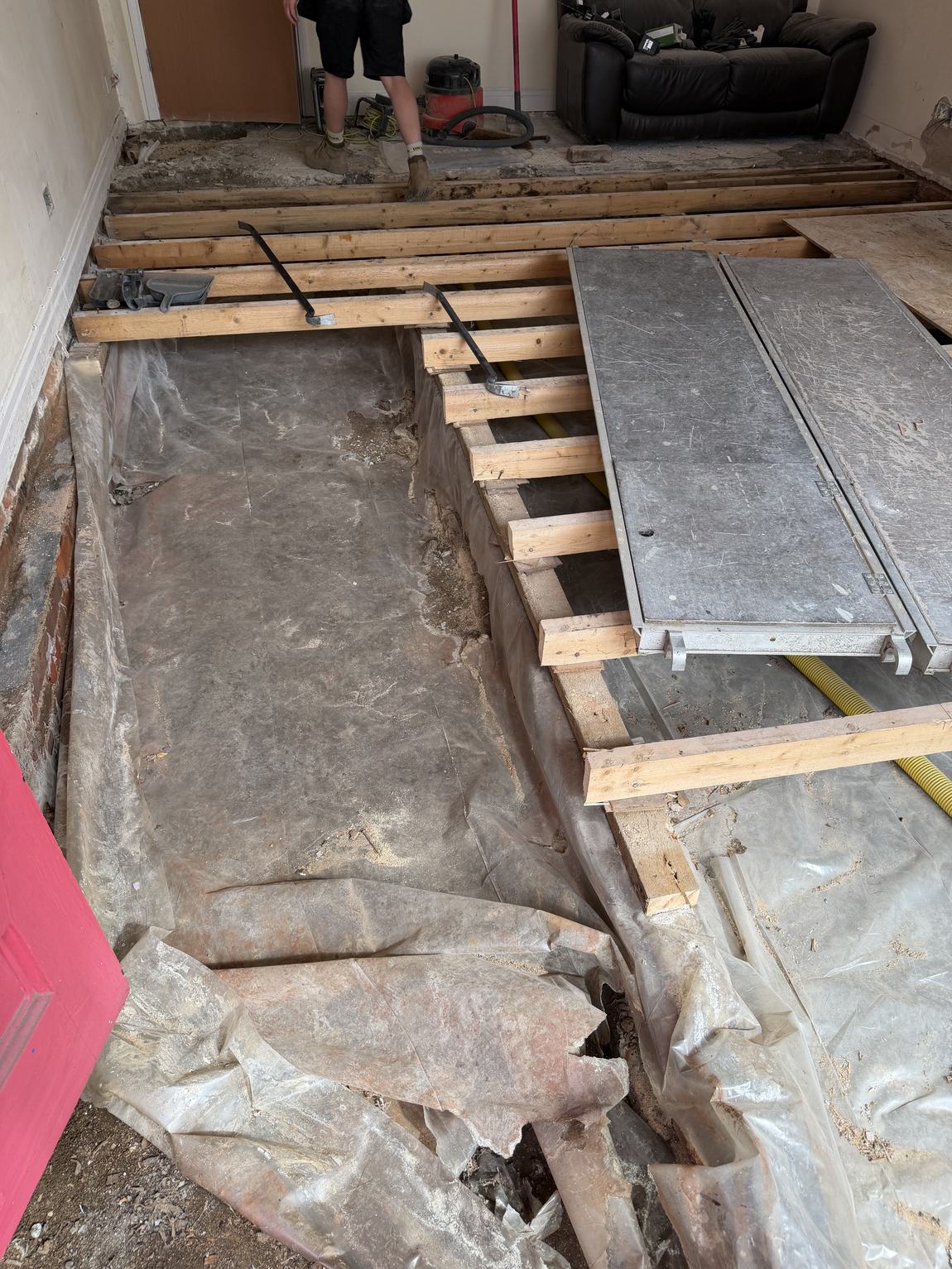

The only honest fix was to remove the void altogether. Membrane tanked
up the walls, then a reinforced slab poured across the whole footprint.
No subfloor, nowhere for the damp to come back to, done properly once.
Curing time: up to twelve weeks. There is no montage for this part
either.
Tanked, taped, and ready.Poured. Now do nothing for three months.
Opening: Autumn 2026
June 2026
The reformers move house
"A month or two" had quietly become four, at storage rates, for
equipment sitting in the dark doing nothing.
I finally accepted that the studio was not about to open, hired the
largest van Enterprise would part with, and moved the lot to my sister's
garage. My niece supervised, and after a brief handover worked out the
steering wheel faster than felt entirely reasonable.
Doing this in March would have saved a fortune. But what is the true
cost of optimism.
The largest van they would give me.Picked it up quicker than expected.Safe, dry, and free.
Opening: Autumn 2026
August 2026 — now
One last strip of screed
To bring the whole floor level, one last strip of screed had to come off
the old slab at the back. A thin layer, we thought. A day, we thought.
It is important to hire experts. We did not have time to hire experts.

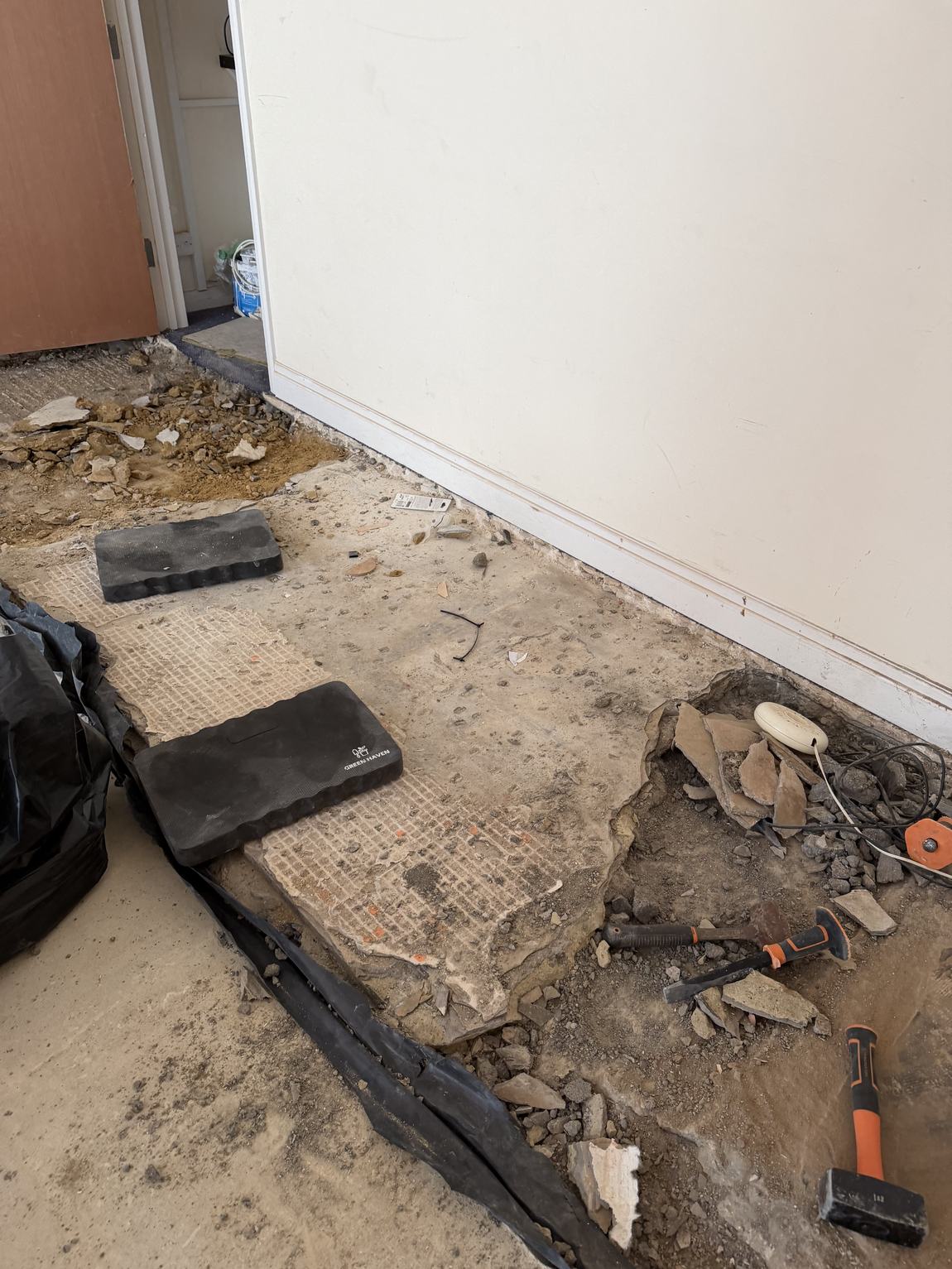

It transpires there are three separate concrete sections back there, at
three different depths, of three different hardnesses. Back to the
drawing board — a place we now know well and find quite comfortable.
A Pilates instructor with a sledgehammer.VideoIt is important to hire experts.VideoIt's lucky I learn quickly.Three depths. Three hardnesses. One drawing board.
Opening: Autumn 2026, probably
Nearly.
Floor, mirror wall, fascia. Then five reformers out of that garage and
into a room that has taken fifteen months because we would rather it were
right than quick.
Pre-register and we'll tell you the moment there is a date worth trusting.
